Flood control project in Hanoi has not reached the finish line after nearly 10 years

HỮU CHÁNH |

Hanoi streets turned into rivers after heavy rains while the flood prevention project, with an investment of more than 7,000 billion VND, has not been completed after nearly 10 years of construction.

In 2015, Hanoi started a project to improve the drainage system in the western area of ​​Hanoi (Yen Nghia drainage pumping station).

The project aims to help drain more than 6,000 hectares of agricultural land, supporting drainage in Ha Dong district, Hoai Duc district, Dan Phuong district and part of Nam Tu Liem district.

The project has a total investment of more than 7,000 billion VND, invested by the Hanoi Department of Agriculture and Rural Development, with two main items: Yen Nghia Pumping Station and the hardening of the entire La Khe canal.

After 5 years of construction, in January 2020, Yen Nghia Pumping Station was completed, with 10 units, with a capacity of 120m3/second.

Since its completion, Yen Nghia Pumping Station has never operated at its full capacity of 120m3/s. During the days when Hanoi was flooded after Typhoon Yagi, Yen Nghia Pumping Station operated at maximum 7/10 units.

These days, although the rivers and lakes in Hanoi are full of water, Yen Nghia Pumping Station is still "thirsty". Only 3-4 units of the pump are in operation and the water channel leading to the pumping station is exhausted.

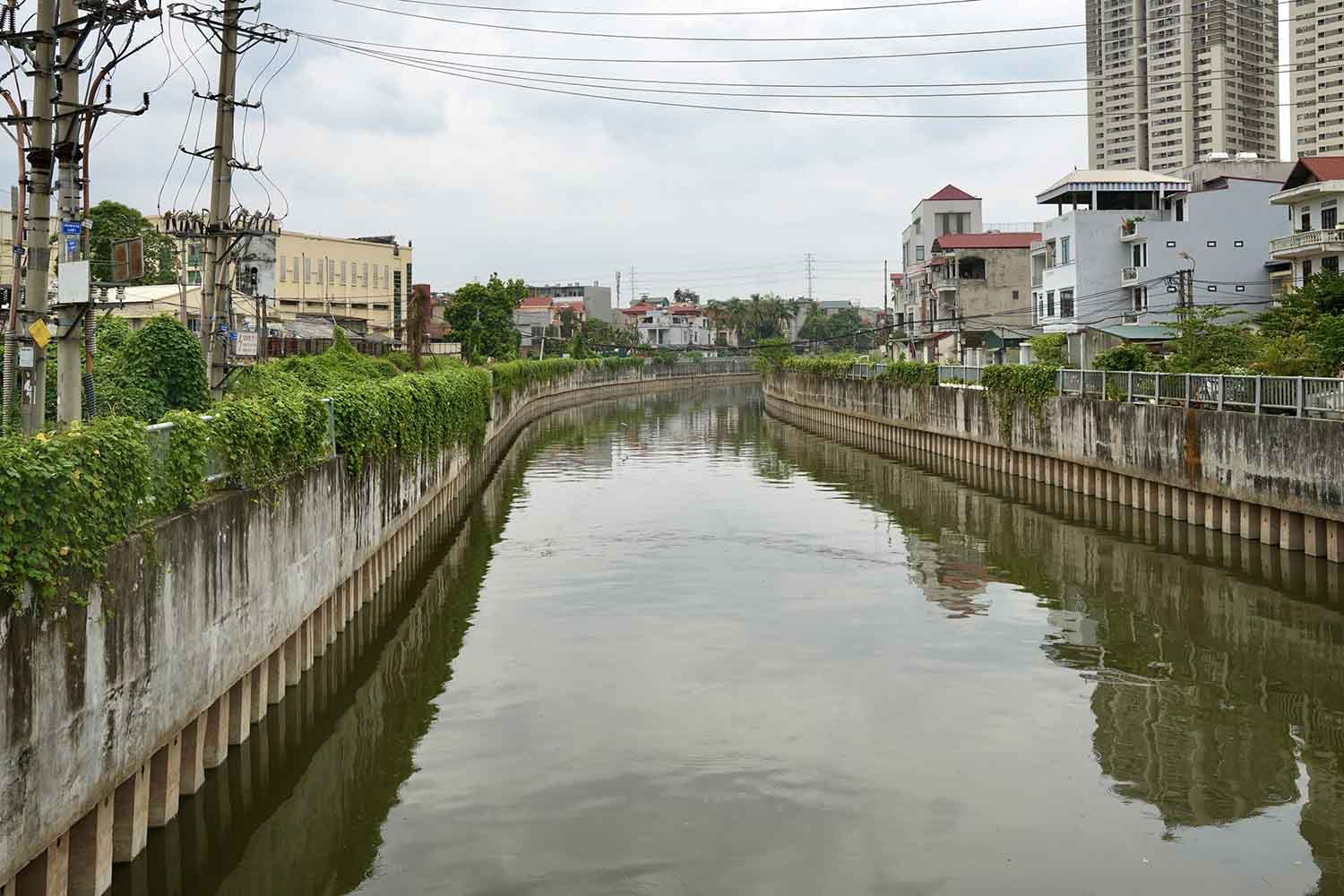

The reason for this situation is that the project of hardening the entire La Khe canal (which carries water from the Nhue River to the pumping station) has not been completed due to problems in site clearance.

Therefore, although Yen Nghia Pumping Station is put into use, the western area of ​​Hanoi suffers from flooding every time it rains heavily.

According to the report of the People's Committee of Ha Dong district, up to now, the La Khe canal project still has more than 150 households that have not handed over the land, with a total area of ​​about 0.6 hectares.

These households are scattered along the canal, in wards such as Quang Trung, Ha Cau, Yet Kieu, Duong Noi, and La Khe.

Recently, Ha Dong district has answered people's questions, explained compensation policies, resettlement support, and mobilized households to comply with land acquisition decisions.

However, many cases still do not comply. Therefore, the district has established records and forcibly recovered land according to regulations.

Ha Dong District aims to complete site clearance work in 2024 and complete the hardening of the entire La Khe canal by the end of 2025.

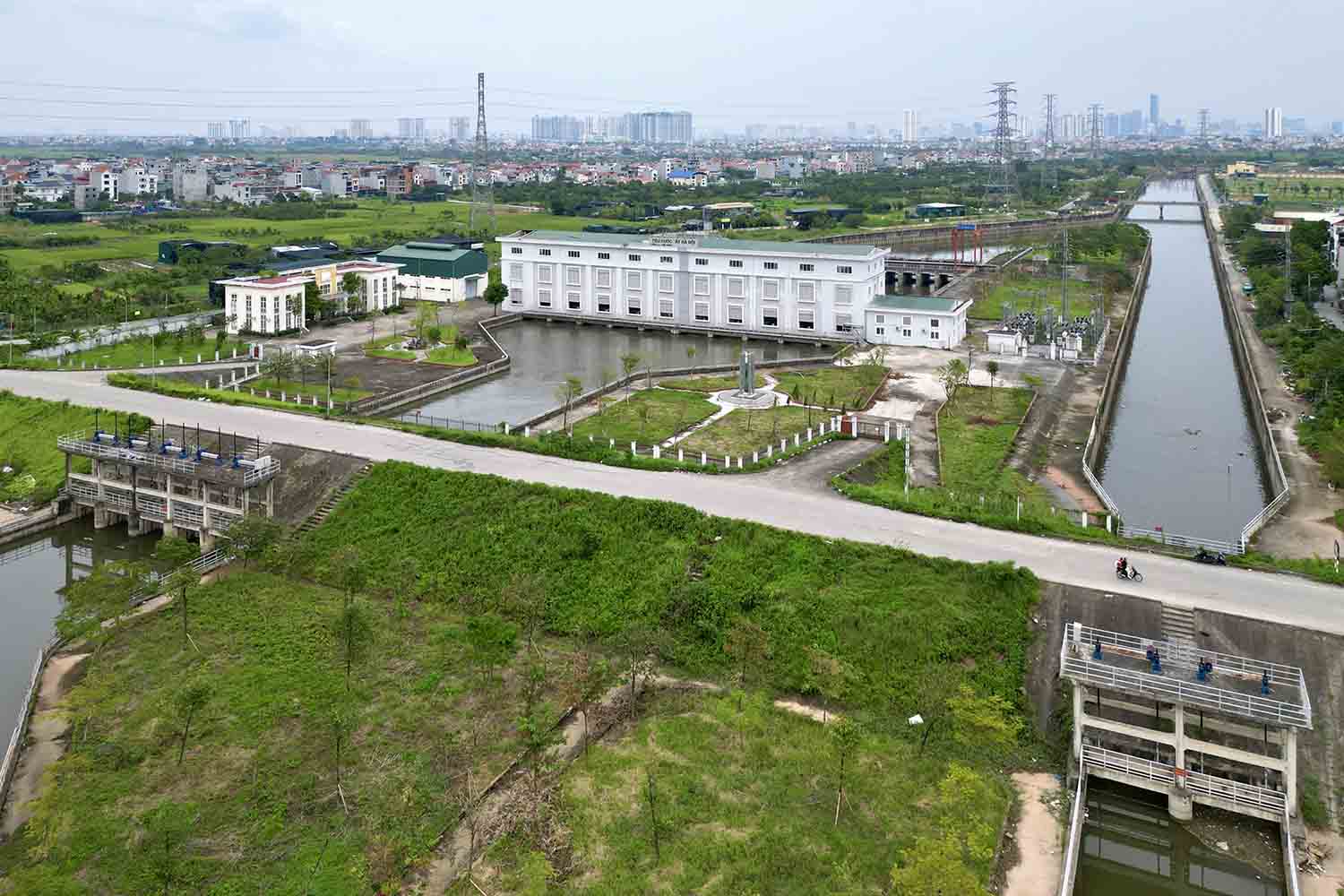

Du an co hang muc quan trong nhat la 10 to may bom, xa lu voi cong suat 120 m3/s, gap 1,5 lan cong suat tram bom Yen So va la tram bom lon nhat Ha Noi hien nay.
The most important item of the project is 10 pumping units, releasing flood water with a capacity of 120 m3/s, 1.5 times the capacity of Yen So Pumping Station. This is also the largest pumping station in Hanoi at present. Photo: Huu Chanh

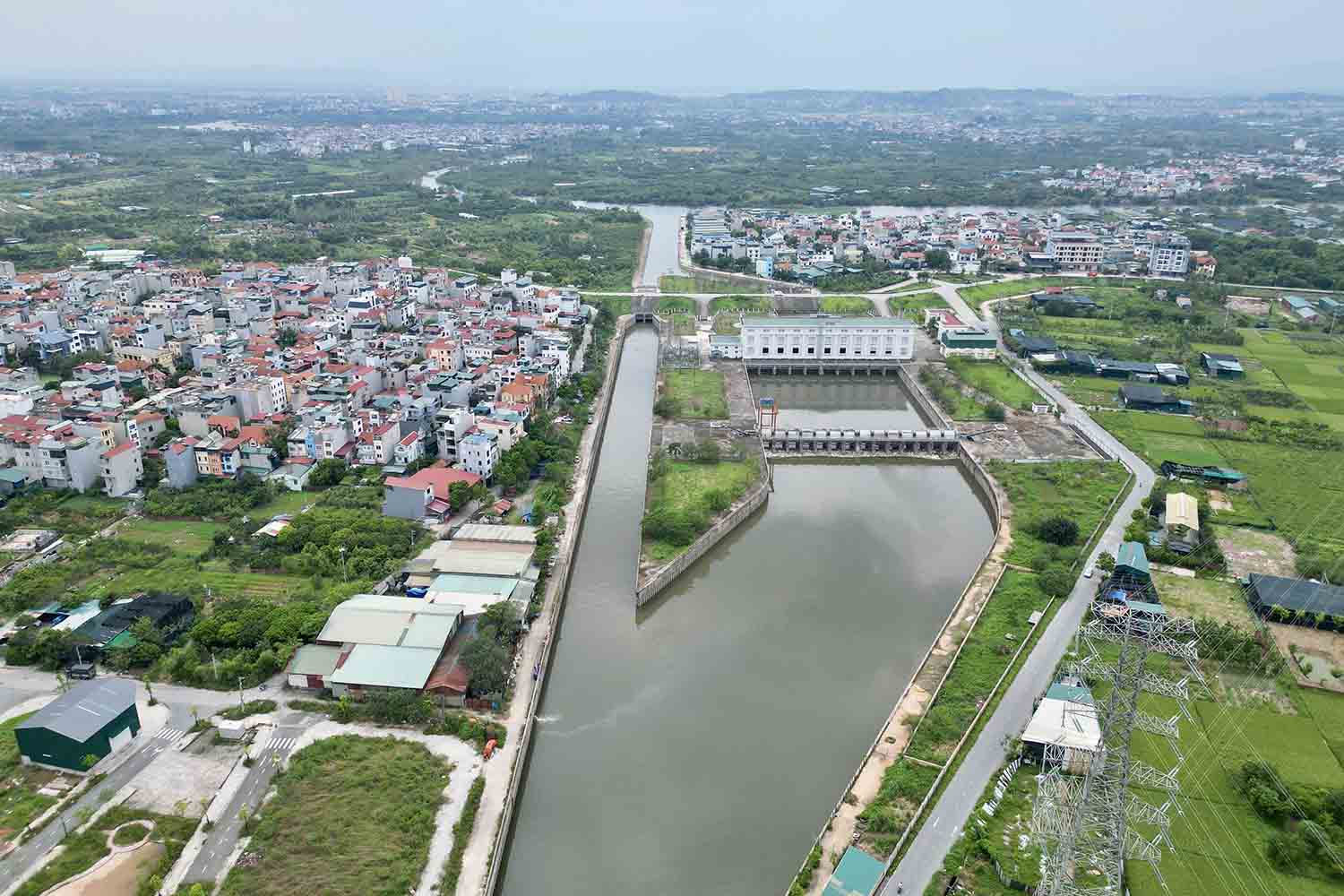

don vi van hanh tram bom Yen Nghia cho biet, nha may luon san sang hoat dong ca 10 to may, tuy nhien, do luong nuoc tu kenh dan ve be chua khong du nen nha may chi hoat dong duoc 4 den 7 to may.
The Yen Nghia Pumping Station operator said that the plant is always ready to operate all 10 units, however, due to insufficient water from the canal to the reservoir, the plant can only operate 4 to 7 units. Photo: Huu Chanh

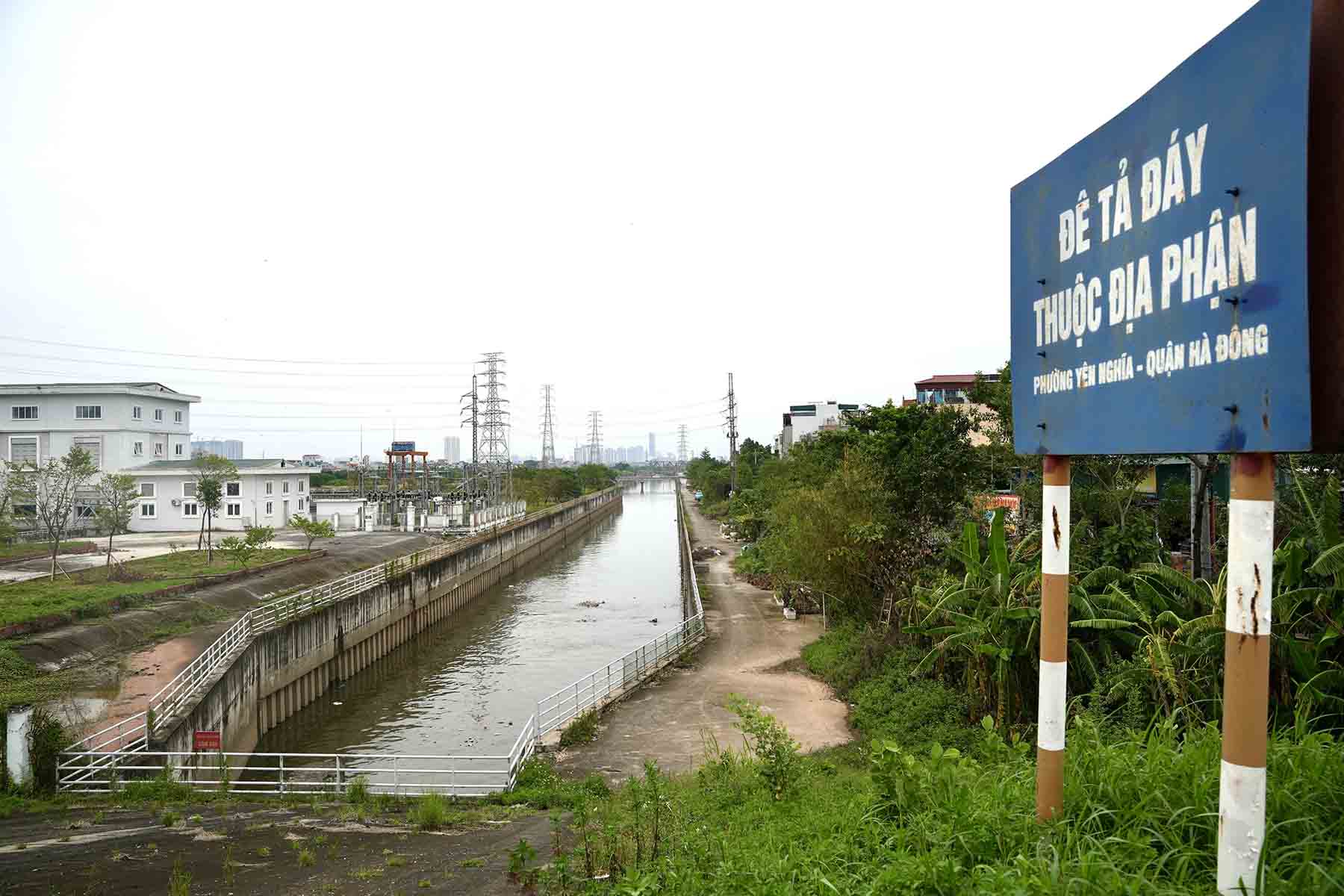

Tuy nhien, hien nay do nha may da xay dung xong nhung kenh dan nuoc xay dung chua xong nen nha may chua co nuoc de hoat dong het cong suat.
Due to construction site problems at the La Khe water channel, the factory is only operating at 40-60% capacity. Photo: Huu Chanh

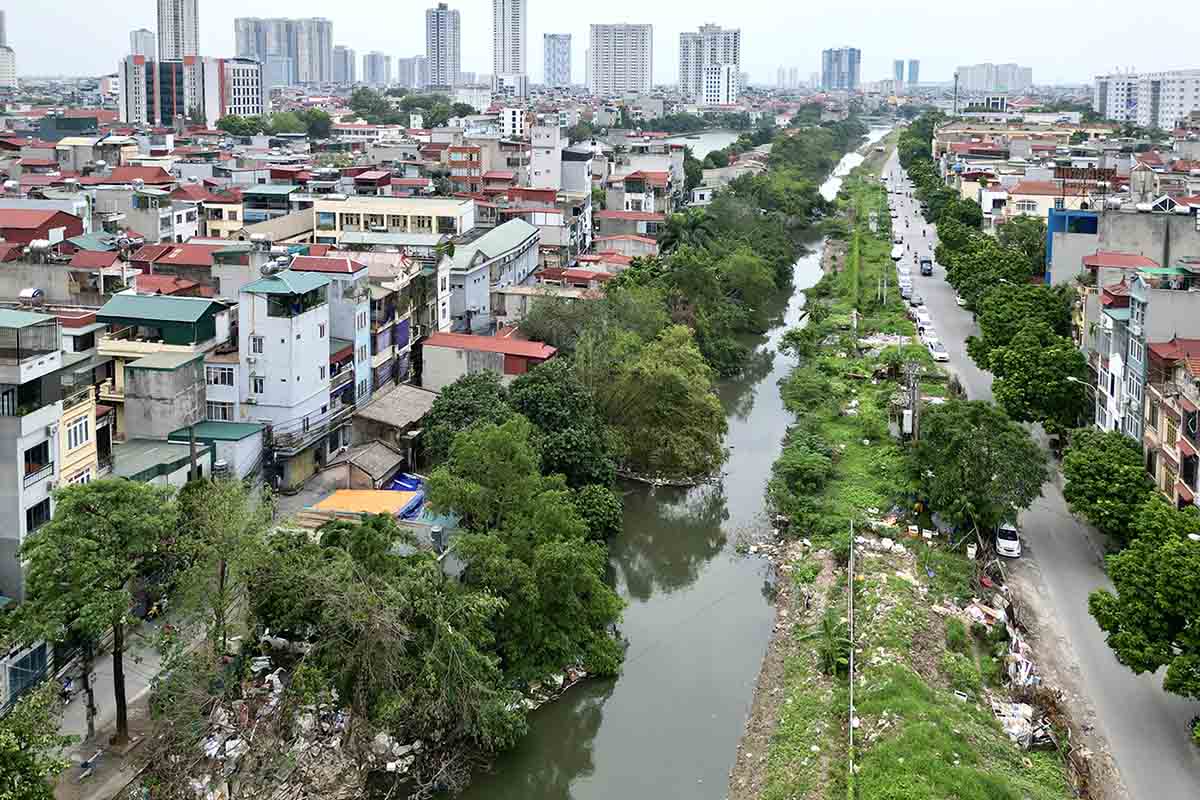

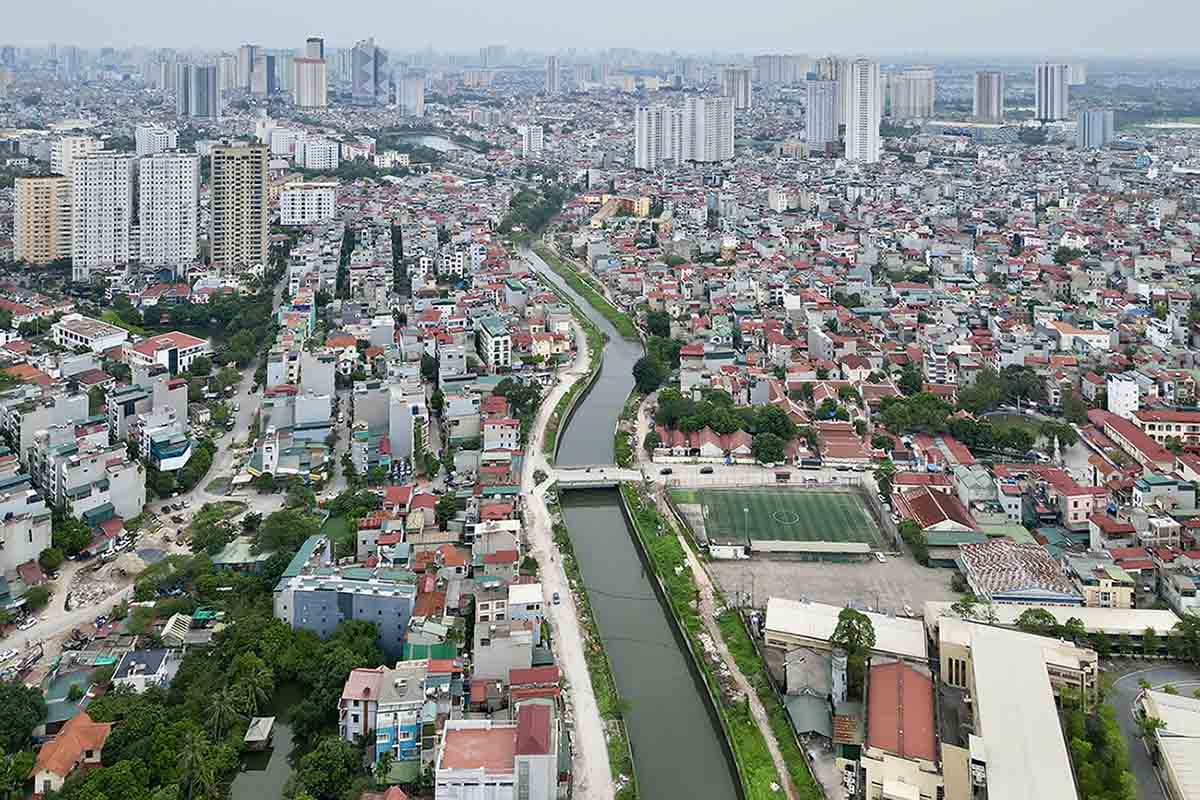

Hien du an con khoang 2,5 tren tong chieu dai 5,8 km kenh chua duoc UBND quan Ha Dong giai phong xong mat bang.
Up to now, the project has about 2.5km out of the total length of 5.8km of the canal that has not been cleared by the People's Committee of Ha Dong district. Photo: Huu Chanh

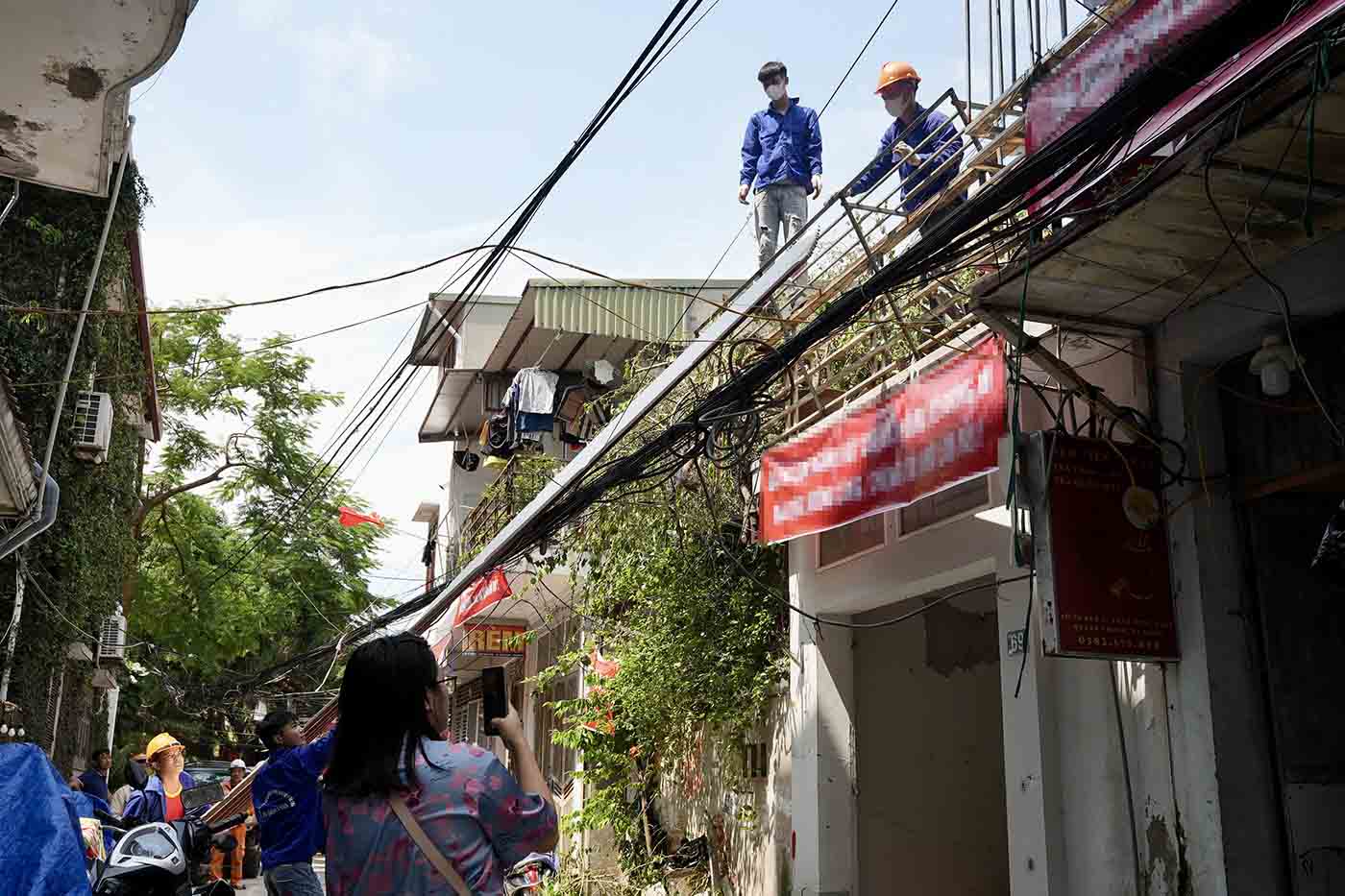

a
According to statistics, there are more than 150 households living along La Khe canal who have not agreed to hand over the land. Photo: Huu Chanh

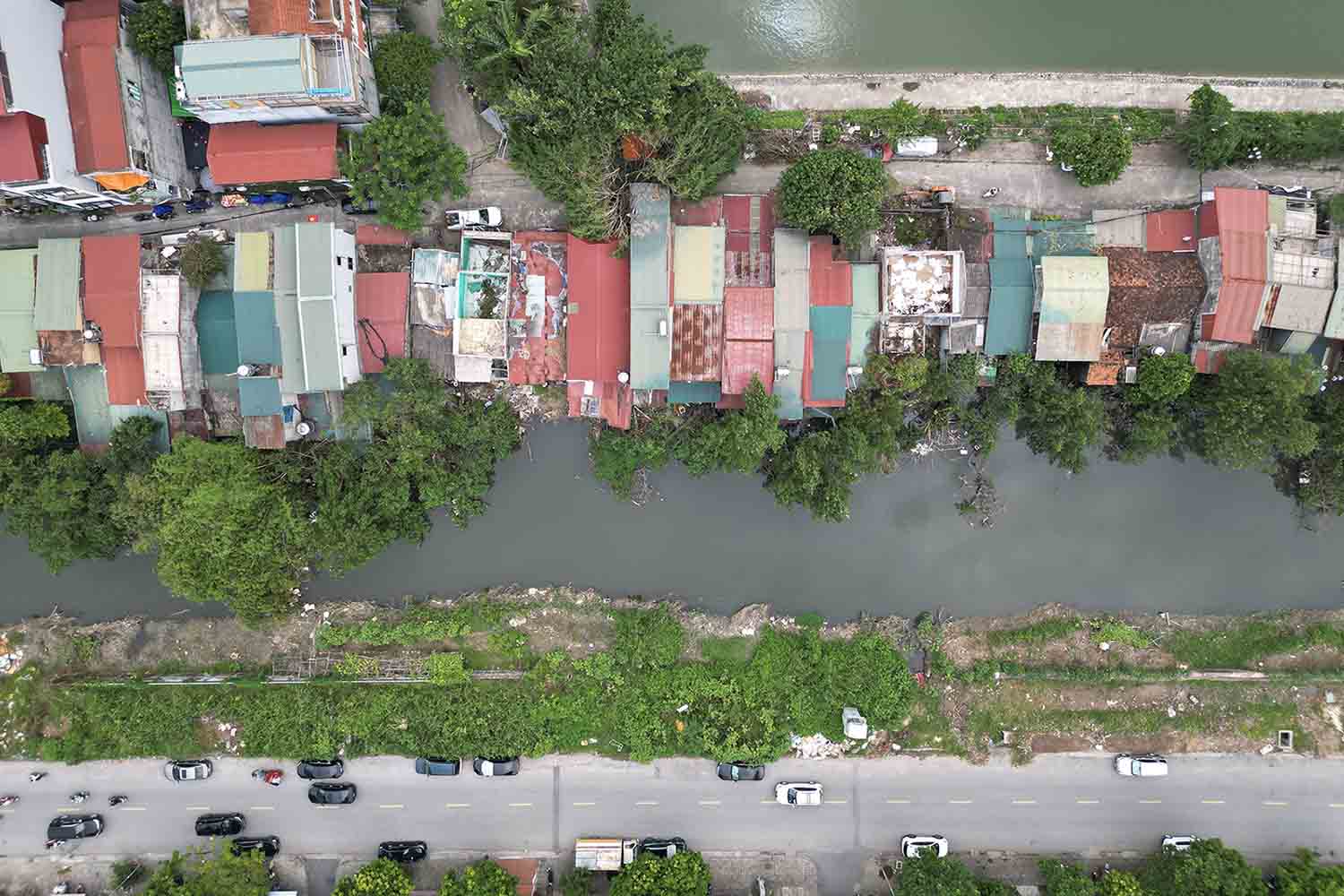

a
Mobilized by the government, in recent days, some households in Quang Trung ward (Ha Dong) have dismantled their constructions and handed over the site to the project. Photo: Huu Chanh
Mot so doan thuoc hang muc kenh dan La Khe cham tien do nen den nay, cac nha thau chua the thi cong dong bo hai ben bo kenh.
According to records, some sections of the La Khe canal project are behind schedule, so up to now, contractors have not been able to synchronously construct both sides of the canal. Photo: Huu Chanh

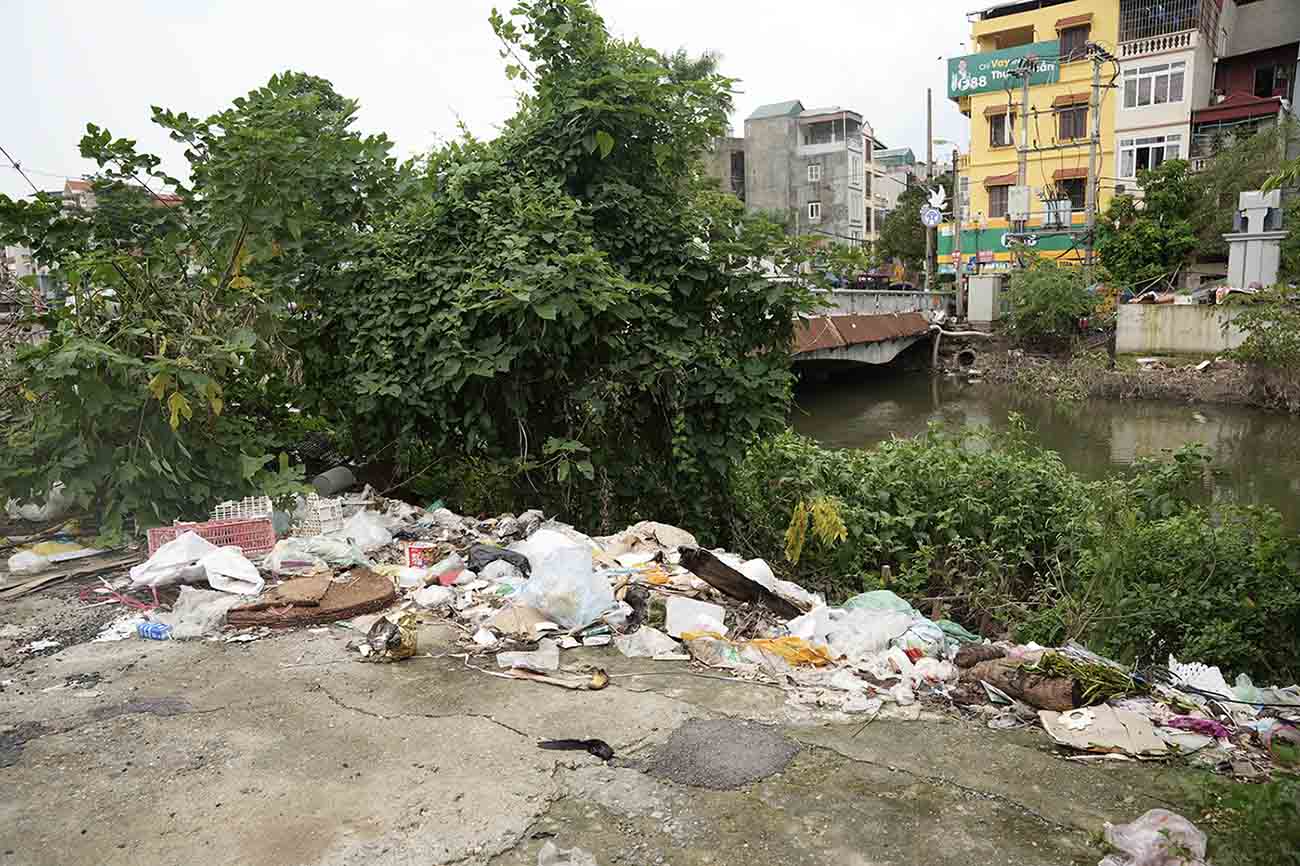

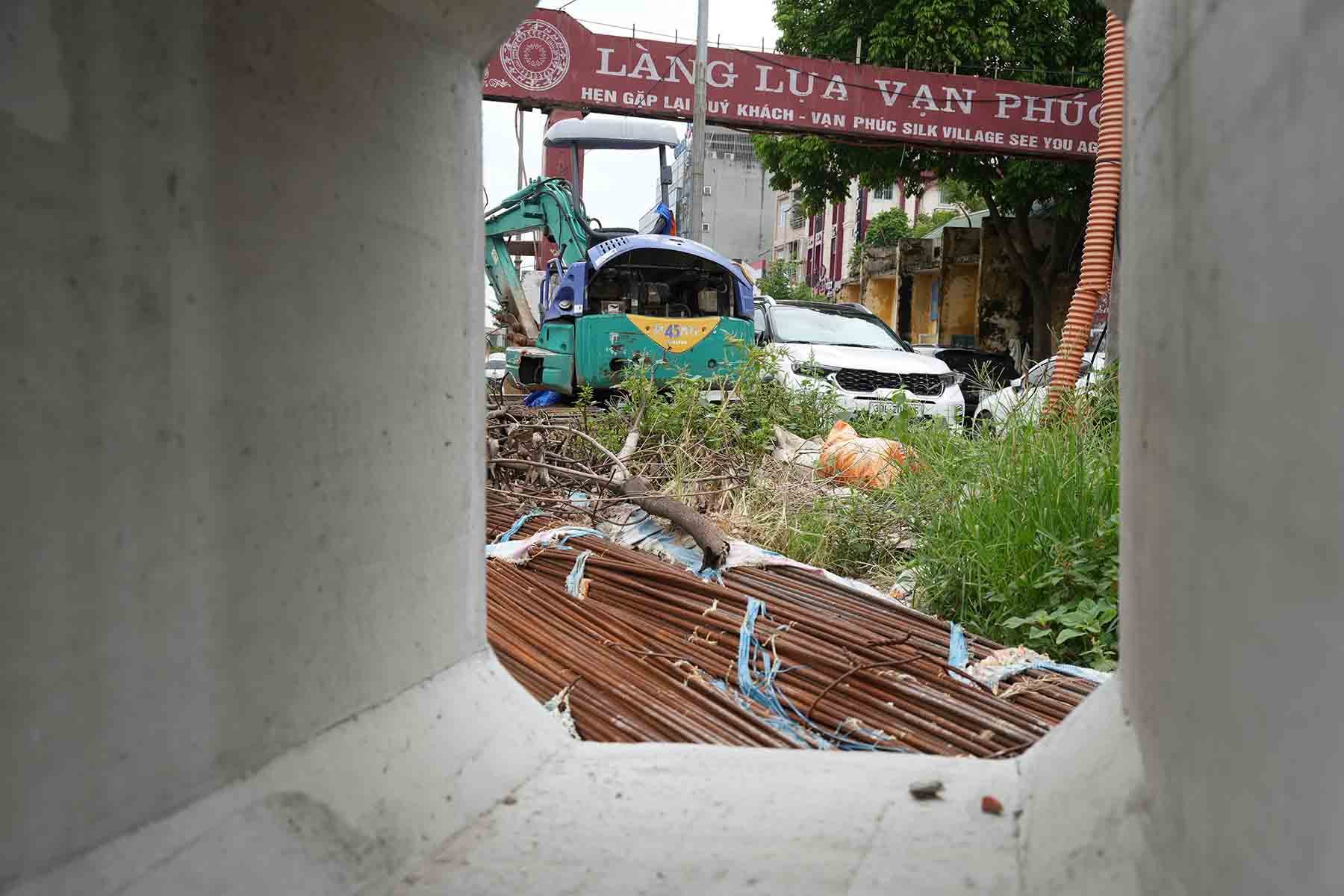

Rac thai un u, phe thai xay dung va thuong bi mot so nguoi do bua bai doc hai ben bo kenh gay o nhiem moi truong. Anh: Huu Chanh
Garbage, construction waste and some people often dump it haphazardly along both sides of the canal, causing environmental pollution. Photo: Huu Chanh
aa

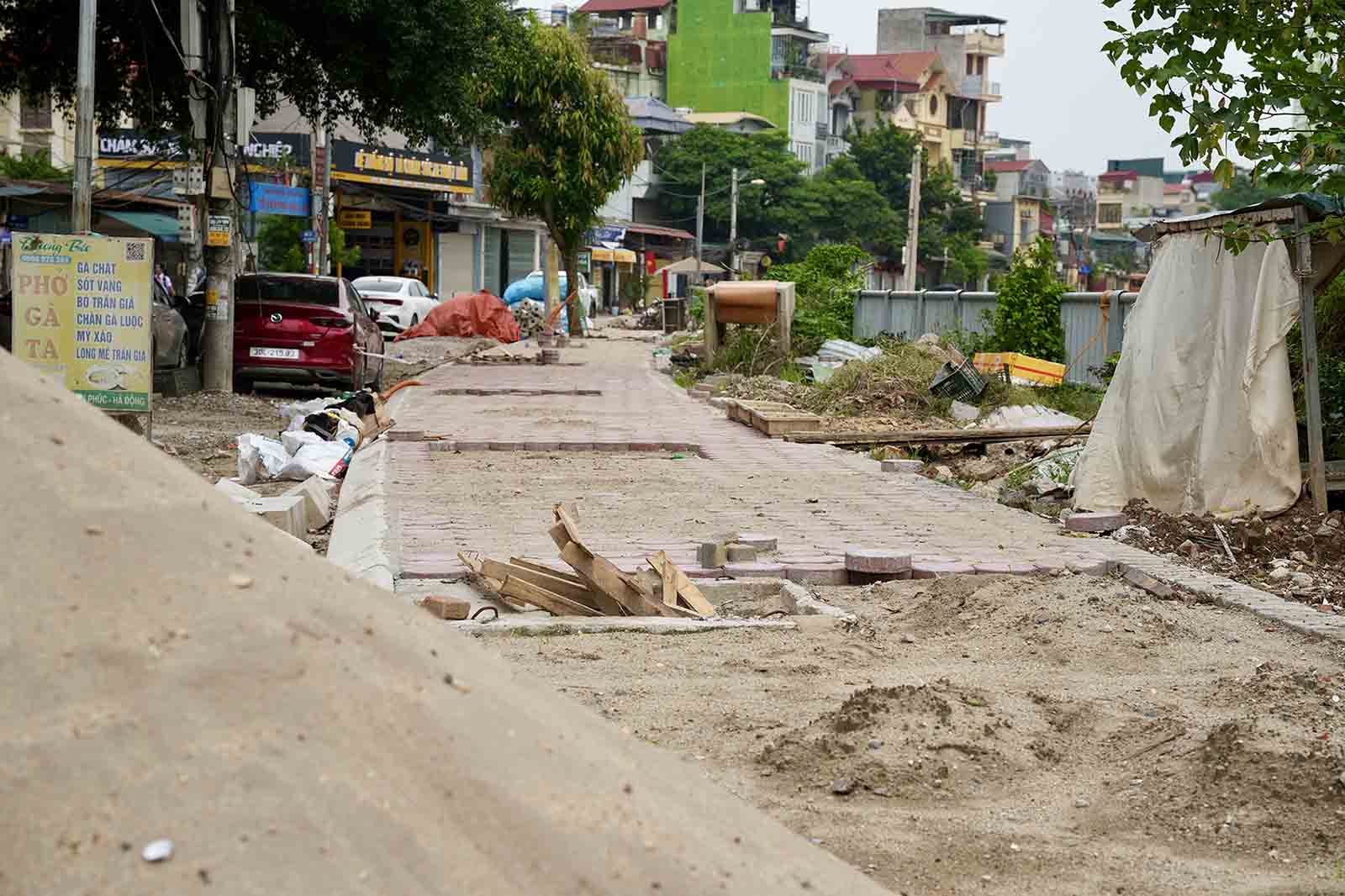

Unfinished sidewalk, littered with machinery and construction materials. Photo: Huu Chanh
Hien du an con khoang 2,5 tren tong chieu dai 5,8 km kenh chua duoc UBND quan Ha Dong giai phong xong mat bang. Anh: Huu Chanh
Ha Dong District aims to complete site clearance work in 2024 and complete the hardening of the entire La Khe canal by the end of 2025. Photo: Huu Chanh

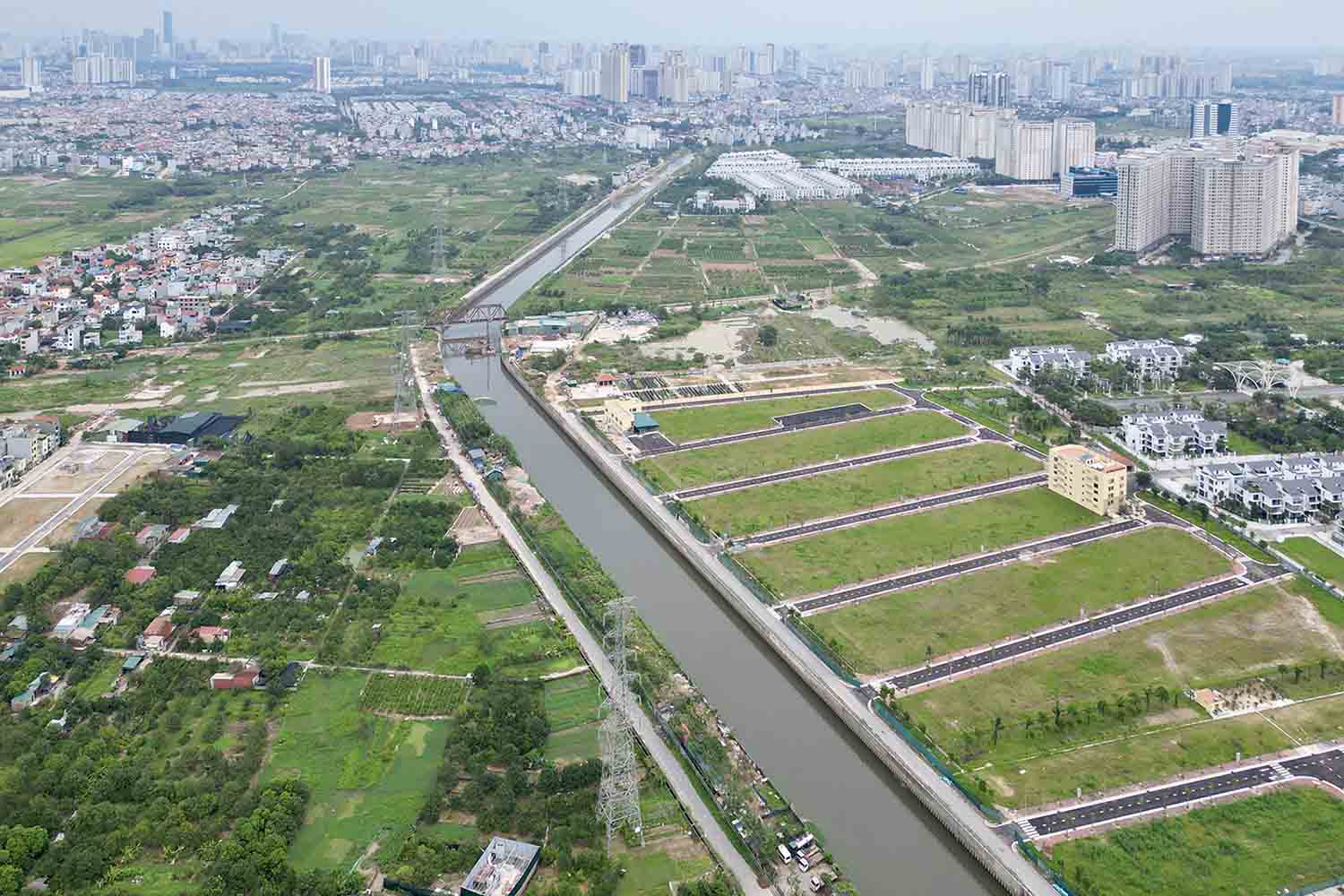

tieu ung cho dia ban cac quan, huyen Ha Dong, Hoai Duc, Bac-Nam Tu Liem, khu vuc My Dinh va mot phan dai lo Thang Long…
When completed, the project will help drain water from the districts of Ha Dong, Hoai Duc, Bac - Nam Tu Liem, My Dinh area and part of Thang Long Avenue... Photo: Huu Chanh
HỮU CHÁNH
