People suffer because unfinished projects have turned into a pollution gap in the capital

Nhóm Phóng viên |

The sewer renovation project in Long Bien (Hanoi) has been unfinished for more than ten years, people have to live next to a polluted black water hole.

Pollution surrounded by unfinished projects

According to Lao Dong reporter in November 2025, the project area next to lane 44 Tu Dinh street, Long Bien ward (Hanoi) still has about 300m of open ditches that have not been constructed with sewers.

Wastewater and household waste are dumped directly into the stagnant ditch, turning this area into a polluted "hot spot" in the middle of a crowded residential area. Nearly 80 households living along the ditch have to endure the strong stench every day.

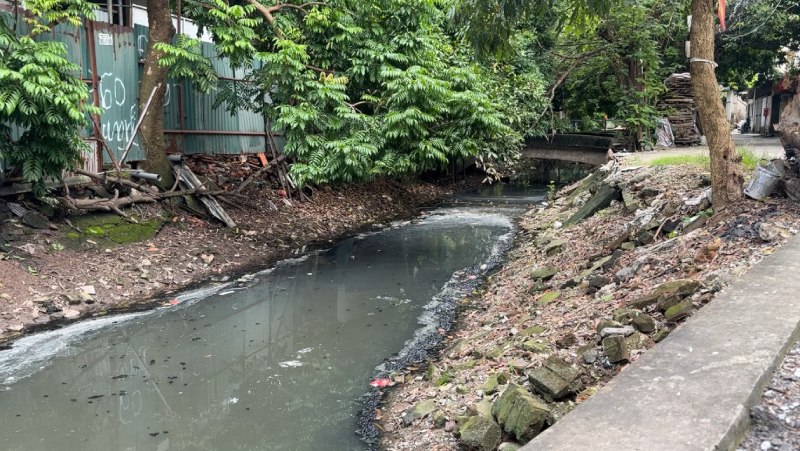

Doan muong suot bao nam thang thanh “diem nong” o nhiem. Anh: Nhom PV

The ditch has become a "hot spot" for pollution for many years. Photo: PV Group

Ms. Nguyen Thi Mai - Head of Residential Group No. 27, Long Bien Ward - said: "This ditch has been polluted for a long time. In 2016, the renovation project was approved. But it is not yet complete. The ditch contains all the waste of the locality, in these families flowing out, the large market also flows out. Since that year, the ditch has not been completed, the ditch is heavily polluted, seriously affecting people's health".

According to Ms. Mai, for many years, the unfinished project and polluted environment have been reported by people at meetings and meetings with voters of the ward and city but have not been completely resolved.

Ba Nguyen Thi Mai - To truong to dan pho so 27 cho biet da nhieu lan kien nghi ve anh huong tu du an dang do nhung khong duoc giai quyet triet de. Anh: Nhom PV

Ms. Nguyen Thi Mai - Head of Residential Group No. 27 said that she has repeatedly made recommendations about the impact of the unfinished project but it has not been completely resolved. Photo: PV Group

Sharing with reporters, Mr. Dinh Ngoc Tuoc (69 years old, Residential Group No. 7, Long Bien Ward) expressed his frustration at the fact that the project has not been completed for decades, causing insecurity for people's lives.

"I don't know why the units couldn't complete this ditch. This is an environmental pollution outlet. People are sick, mosquitoes get burned, and dengue fever also comes from here. But I have had a project for a long time and I cannot do it," Mr. Tuoc expressed.

The project was approved more than 10 years ago

The project to renovate the sewer system connecting Vuc Lake, Dau Bang Lake and Tu Dinh Lake (Long Bien Ward, Hanoi) was assigned by the Hanoi People's Committee to the New House Trading Joint Stock Company (La Vong Group) to implement. The project was approved by the Prime Minister in Notice No. 88/TB-VPCP dated March 25, 2010.

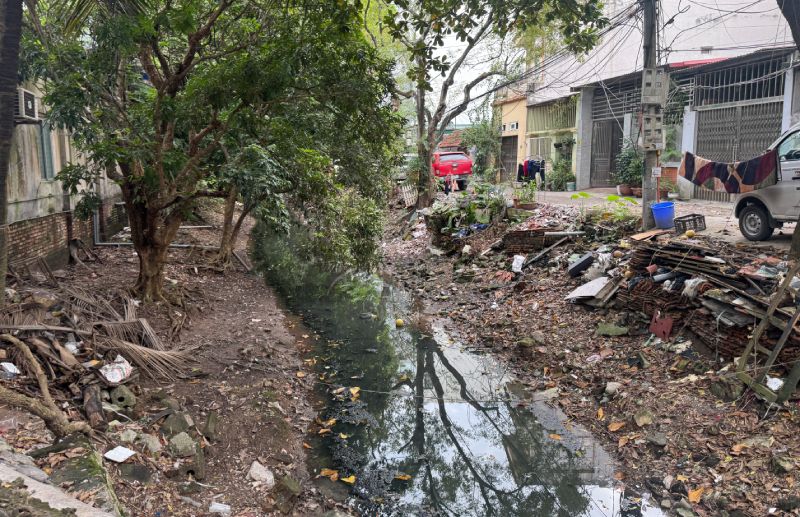

Nguoi dan lo ngai ve tinh trang o nhiem ngay mot nghiem trong cua doan muong. Anh: Nhom PV

People are concerned about the increasingly serious pollution of the ditch. Photo: PV Group

The project was approved for a Feasibility Study Report under the form of a BT contract in Decision No. 580/QD-UBND dated February 2, 2016.

On that basis, in 2016, the People's Committee of Long Bien District (old) signed a BT Contract with the New House Trading Joint Stock Company.

At that time, the project was invested synchronously including the following items:

Construct a system of reinforced concrete drainage boxes connecting Dau Bang Lake, Vuc Lake and Tu Dinh Lake in Bo De Ward and Long Bien Ward, Long Bien District, with a length of 1,855m in the planned route. Returning the site on the sewers and completing the technical infrastructure system; burying the medium-voltage power line through the project area.

Build a system of trees, lawns, walking paths, and sports fields within the renovated boundary above the sewers to serve the needs of local residents.

In particular, the sewer line passing through the Long Bien ward residential area will be arranged with a traffic route to serve residents on both sides of the road.

The total investment of the project is about 610.834 billion VND. Some main costs include: compensation for site clearance and resettlement costs: VND 114.4 billion; construction costs: VND 389.1 billion; interest during the construction period: VND 33.7 billion; contingency costs: VND 52.4 billion. The construction period of the route (expected): 18 months (from October 2016 to March 2018).

At that time, the project to invest in renovating and constructing a sewer system connecting Vuc Lake, Dau Bang Lake and Tu Dinh Lake, Long Bien District, proposed by the New House Joint Stock Company, was assessed as a project that plays an important role in taking advantage of social resources to synchronously complete the urban technical infrastructure system according to the approved planning of Long Bien in particular and Hanoi City in general.

The project will solve the problem of drainage of rainwater and wastewater for the entire southern Long Bien area; create a landscape environment, improve people's lives; improve land use efficiency to serve local socio-economic development.

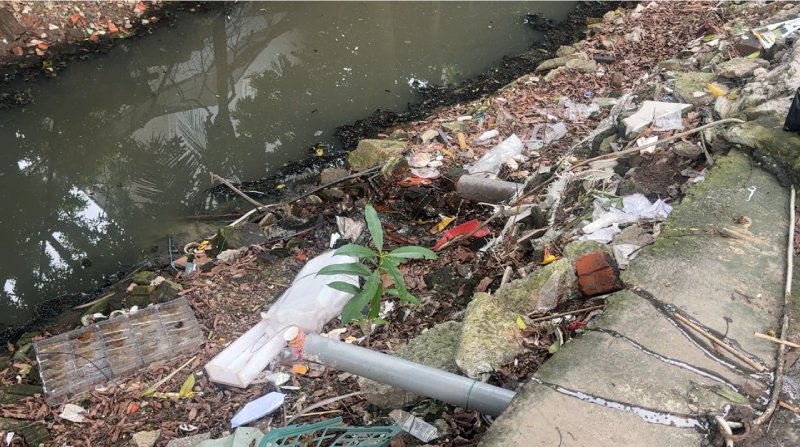

Rac, nuoc thai sinh hoat cung do thang ra doan muong. Anh: Nhom PV

Garbage and domestic waste are dumped directly into the ditch. Photo: PV Group

In order to clarify when this project will be completed and related legal issues, on November 19, a reporter from Lao Dong Newspaper directly went to Long Bien Ward People's Committee to send specific working documents and questions. On November 20, the reporter also sent a letter of introduction and questions to the New House Trading Joint Stock Company (La Vong Group).

The reporter continued to contact Mr. Le Van Vong, Chairman of La Vong Group by phone on December 2. However, Lao Dong Newspaper reporters have not received a response from La Vong Group.

The reporter repeatedly contacted Mr. Hoang Hai, Chairman of the People's Committee of Long Bien Ward. On December 2, Mr. Hoang Hai said he had grasped the issue and directed the specialized agency to respond.

Nhóm Phóng viên
