The construction volume of the 500kV circuit 3 project in Ha Tinh is still large

TRẦN TUẤN |

On the morning of July 23, a report from the Department of Industry and Trade of Ha Tinh showed that the current construction volume of the 500kV circuit 3 project in Ha Tinh is still very large.

Accordingly, currently the 500kV circuit 3 project in Ha Tinh has completed construction of 232/285 columns; Currently erecting poles at 53 positions, have completed pulling the rope for 13/113 anchor intervals, and are pulling the cord for 28 anchor intervals.

Recently, localities in Ha Tinh with passing projects have mobilized available resources and forces, creating all conditions for investors and construction units to best organize logistics work. Food, accommodation, activities, and travel ensure convenience, hygiene, safety, and health for officers, engineers, workers, and laborers.

However, the construction encountered many difficulties, especially in Ky Anh town, the line went on the Hoanh Son range, the terrain was high and rugged, strong Lao wind, and heavy rain made the construction work of erecting poles difficult. Pulling wires is very complicated, including transporting supplies and materials to the construction site.

Ha Tinh Department of Industry and Trade also said that when the rainy season begins, it will cause many difficulties for construction work on the 500kV circuit 3 line construction site.

At an online meeting on the afternoon of July 22 on the implementation status of the 500kV Circuit 3 Line Project from Quang Trach (Quang Binh) to Pho Noi (Hung Yen) in 3 provinces: Thanh Hoa, Nghe An, Ha Tinh , the Prime Minister requested that in the coming time, ministries, branches, localities and units continue to focus on implementing the project; strive to inaugurate the project on the occasion of the 79th anniversary of the August Revolution and National Day 2.9.

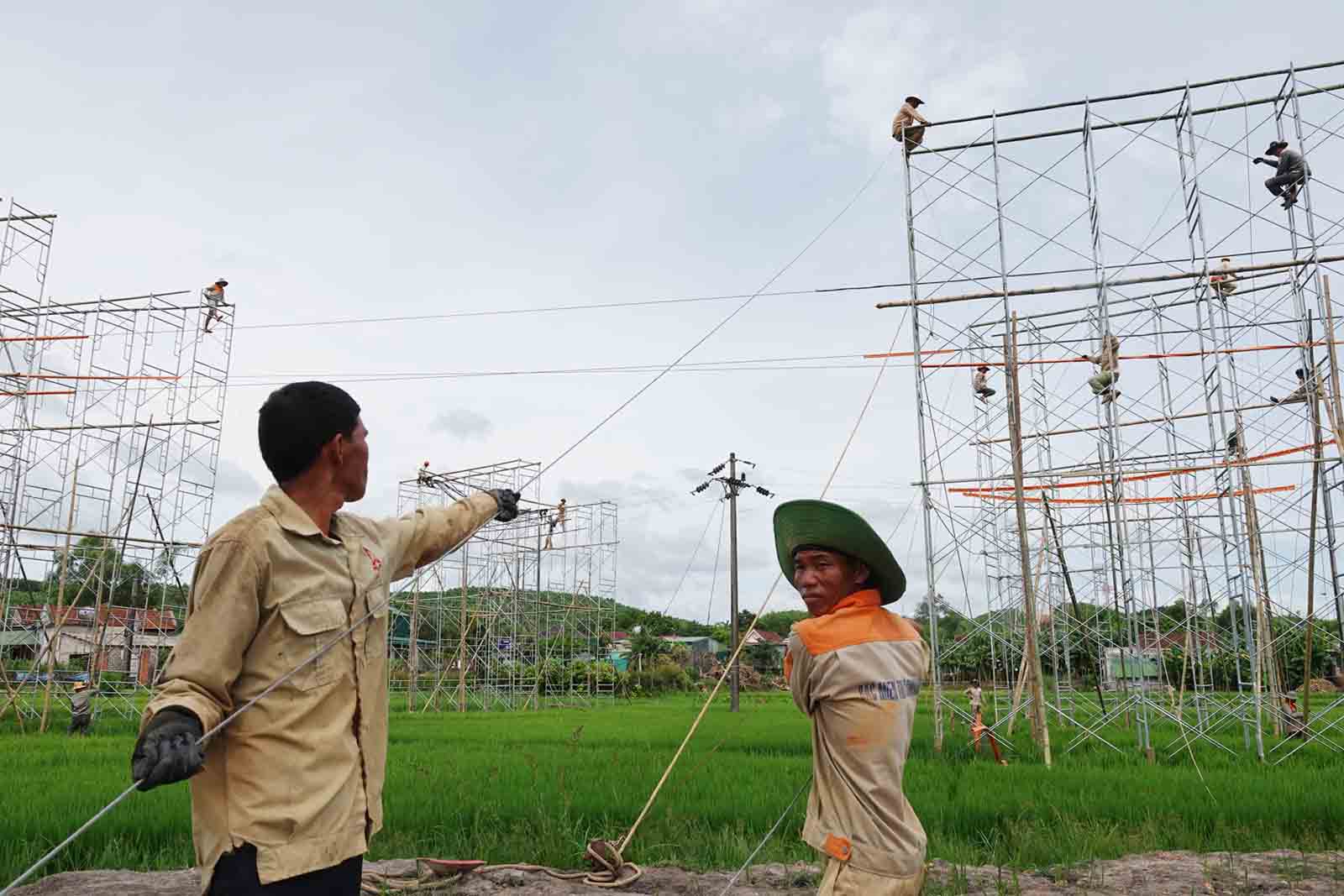

Workers erecting scaffolding prepare to pull the 500kV circuit 3 electric pole wire in Ha Tinh. Photo: Tran Tuan.
Workers erecting scaffolding prepare to pull the 500kV circuit 3 electric pole wire in Ha Tinh. Photo: Tran Tuan.

The Prime Minister requested construction units to rebuild the critical path according to new goals; lightning speed, even more lightning speed; Closer coordination between forces, levels and sectors on the construction site, promoting project construction, ensuring quality, technique, aesthetics, hygiene and labor safety.

At the same time, determined to remove difficulties and overcome challenges with the spirit of "doing it, not giving up"; continue to propagate, create momentum, motivation, and spread confidence throughout the country; do a good job of reconstitution; Prepare for acceptance in accordance with the provisions of law.

At this meeting, Secretary of the Ha Tinh Provincial Party Committee Hoang Trung Dung informed that in recent times, both the political system and the people of Ha Tinh have drastically implemented many solutions in site clearance and mobilization of resources. amount of support for logistics and project construction.

The 500kV circuit 3 electric poles in Ha Tinh have completed pulling wires. Photo: Tran Tuan.
The 500kV circuit 3 electric poles in Ha Tinh have completed pulling wires. Photo: Tran Tuan.

Secretary of the Ha Tinh Provincial Party Committee affirmed that Ha Tinh province continues to focus highly on implementing the Prime Minister's instructions, closely coordinate, accompany and support construction units during the implementation process. Declare items on schedule.

TRẦN TUẤN
TIN LIÊN QUAN

Hoàn thành đường dây 500kV mạch 3 dịp kỷ niệm Quốc khánh

PHẠM ĐÔNG |

Thủ tướng Chính phủ yêu cầu hoàn thành dự án đường dây 500kV mạch 3 chào mừng kỷ niệm 79 năm Cách mạng tháng Tám và Quốc khánh 2.9.

Chạy đua kéo dây trên công trường 500kV mạch 3

TRẦN TUẤN |

Trên công trường 500kV mạch 3 qua Hà Tĩnh, các đơn vị thi công đang khẩn trương kéo dây điện những cột còn lại trên tuyến để sớm hoàn thành dự án.

Động viên người lao động thi công đường dây 500kV mạch 3

Lương Nguyễn |

Ngày 21.7, đoàn công tác của Tổng LĐLĐVN đến tặng quà người lao động thi công đường dây 500kv mạch 3 Quảng Trạch - Quỳnh Lưu, khu vực tỉnh Nghệ An.

Trực tiếp bóng đá Indonesia 0-0 Trung Quốc: Hiệp 1

NHÓM PV |

Trực tiếp trận đấu giữa tuyển Indonesia và Trung Quốc tại vòng loại thứ 3 World Cup 2026, diễn ra lúc 19h00 hôm nay (15.10).

Lý do Trường Đại học Thủ Dầu Một thu vượt học phí 37 tỉ đồng

ĐÌNH TRỌNG |

Trường Đại học Thủ Dầu Một (Bình Dương) thu vượt học phí của sinh viên lên tới 37 tỉ đồng. Số tiền này hiện đã được nộp vào ngân sách nhà nước (sung công quỹ).

Chênh giá 450% trong vụ việc bị Công an Bình Thuận khởi tố

Lam Duy |

Trong vụ việc đấu thầu vừa bị Công an tỉnh Bình Thuận khởi tố, cơ quan thanh tra chỉ ra có thiết bị có giá trị tăng 150 - 450%.

Cập nhật giá vàng chốt phiên 15.10: Vàng nhẫn neo trên đỉnh

Khương Duy |

Cập nhật giá vàng chốt phiên 15.10: Thị trường thế giới ghi nhận đà giảm nhẹ. Trong nước, giá vàng nhẫn tròn trơn neo cao trên ngưỡng kỷ lục.

Vụ công trình làm nứt nhà dân ở Hà Nội, chính quyền nói gì?

NHÓM PV |

Theo chính quyền phường Quang Trung, hình ảnh công nhân đang làm việc tại công trình số nhà 19, ngõ 136/98 Tây Sơn là để hút nước phòng dịch sốt xuất huyết.

Hoàn thành đường dây 500kV mạch 3 dịp kỷ niệm Quốc khánh

PHẠM ĐÔNG |

Thủ tướng Chính phủ yêu cầu hoàn thành dự án đường dây 500kV mạch 3 chào mừng kỷ niệm 79 năm Cách mạng tháng Tám và Quốc khánh 2.9.

Chạy đua kéo dây trên công trường 500kV mạch 3

TRẦN TUẤN |

Trên công trường 500kV mạch 3 qua Hà Tĩnh, các đơn vị thi công đang khẩn trương kéo dây điện những cột còn lại trên tuyến để sớm hoàn thành dự án.

Động viên người lao động thi công đường dây 500kV mạch 3

Lương Nguyễn |

Ngày 21.7, đoàn công tác của Tổng LĐLĐVN đến tặng quà người lao động thi công đường dây 500kv mạch 3 Quảng Trạch - Quỳnh Lưu, khu vực tỉnh Nghệ An.
