18 billion VND to build resettlement area in Lao Cai border village

Đinh Đại |

Lao Cai - Resettlement projects in Muong Khuong commune are being accelerated to move people to new places of residence.

In mid-July 2025, due to the impact of storm Wipha, dozens of households in Dat Chai B village, Muong Khuong commune had to evacuate.

The leaders of Muong Khuong commune have directly mobilized households in Dat Chai B village, located in the high-risk natural disaster area, to evacuate to safety.

Nhieu ho dan o xa Muong Khuong mong du an som hoan thanh. Anh: Dinh Dai
Many households in Muong Khuong commune hope the project will be completed soon. Photo: Dinh Dai

Understanding the insecurity of the people, Lao Cai province has implemented a project to stabilize the population of natural disasters in Dat Chai B village.

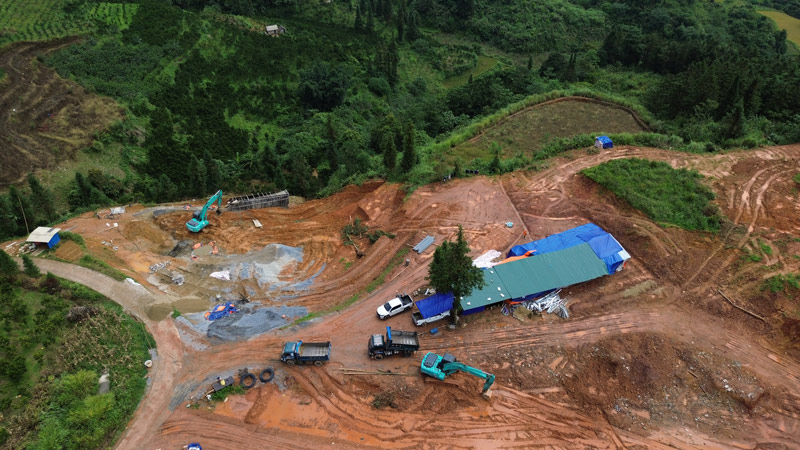

In mid-September, present at the construction site of a resettlement area for people in the border village of That Chai B, a reporter from Lao Dong Newspaper noted the bustling construction activities.

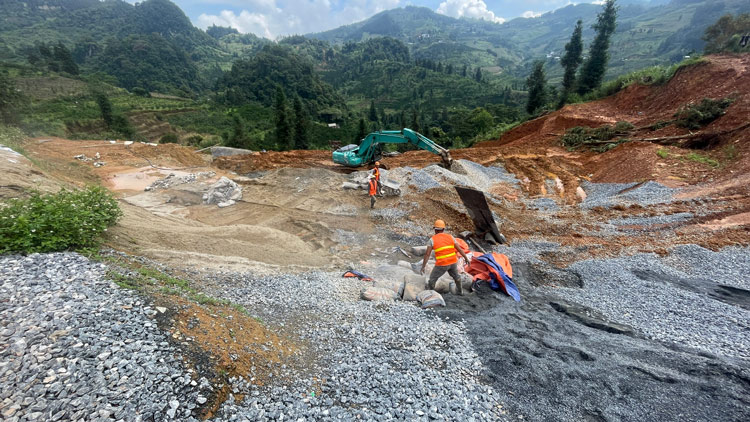

After the rain stopped and took advantage of the sunny weather, large-capacity machines are constructing embankments. Along with that, many workers have started making concrete components.

Cong nhan dang thi cong hang muc ke tai du an tai dinh cu thon Chung Chai B, xa Muong Khuong (tinh Lao Cai). Anh: Dinh Dai
Workers are constructing the embankment at the resettlement project in Dat Chai B village, Muong Khuong commune (Lao Cai province). Photo: Dinh Dai

Through research, the project to arrange and stabilize the population of the disaster village of Dat Chai B has a total investment of 18 billion VND. Capital from the provincial budget, the old Muong Khuong district budget and other capital.

The project is invested by the Muong Khuong Construction Investment Project Management Board.

The new resettlement area was built on an area of about 1.7 hectares, arranged for about 45 households. With many items such as traffic routes; water supply for daily use; electricity supply for daily use; village cultural house; embankment construction...

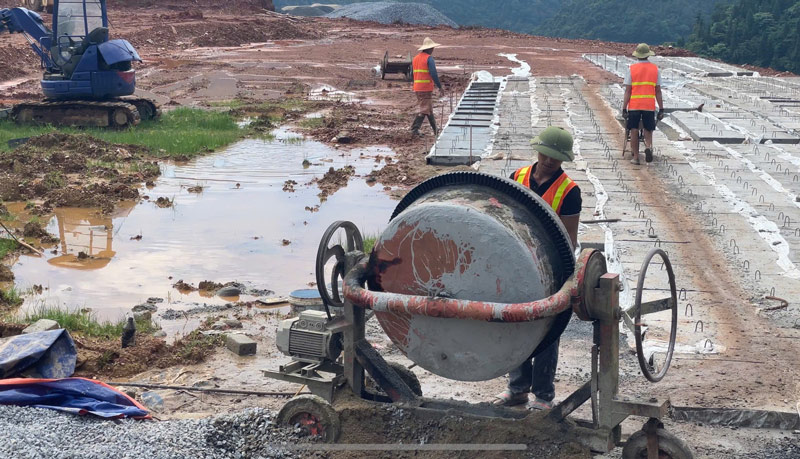

Cong nhan lam cau kien be tong. Anh: Dinh Dai
Workers make concrete components. Photo: Dinh Dai

Mr. Ly A De (a resident of Muong Khuong commune) shared: "Every time there is a flood or the impact of storms, people have to evacuate because of the high risk of landslides that directly threaten their lives. Therefore, people really hope that the resettlement areas will be completed soon to move to build houses, escape the lurking natural disaster situation".

Local people hope to soon move to a new resettlement area so that their lives are no longer uncertain and they have to evacuate every rainy and flood season.

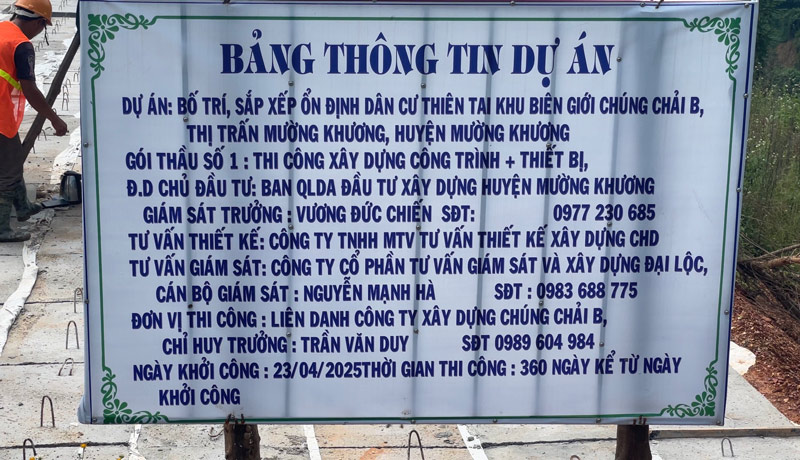

Thoi gian thuc hien cua du an la 360 ngay, tuy nhien chu dau tu phan dau den cuoi thang 12.2025 se hoan thien mat bang de ban giao. Anh: Dinh Dai
The project implementation period is 360 days, however, the investor strives to complete the site for handover by the end of December 2025. Photo: Dinh Dai

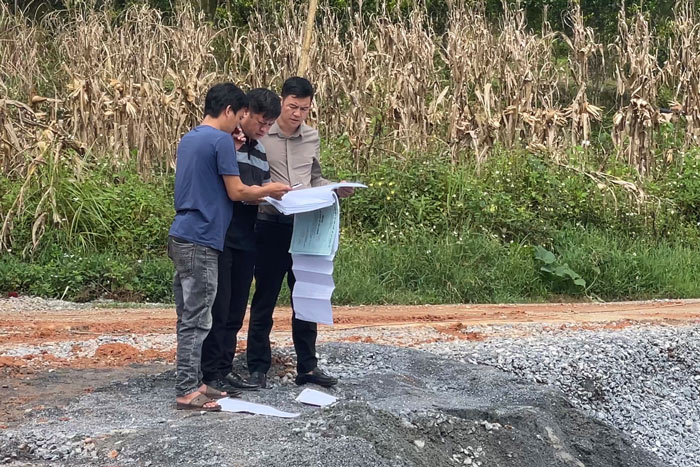

Mr. Bui Sy Ngoc - Director of the Muong Khuong Construction Investment Project Management Board said that after the investor resolved some problems in site clearance, the contractor is currently implementing construction. Up to this point, the construction volume has reached 16% compared to the contract progress.

However, according to Mr. Ngoc, the construction is still facing difficulties due to heavy rain, so they do not focus on synchronously implementing the items.

Mua nhieu khien viec thi cong bi anh huong dang ke, do vay chu dau tu thuong xuyen don doc nha thau de dam bao du an ve dich dung hen. Anh: Dinh Dai
Heavy rain has significantly affected the construction, so the investor often urges the contractor to ensure the project reaches the finish line on time. Photo: Dinh Dai

The investor regularly urges relevant contractors to focus on speeding up construction to complete the project, ensuring progress. It is expected that by December 30, 2025, there will be land to move residents from the landslide risk area to build houses to stabilize their lives," informed the Director of the Muong Khuong Construction Investment Project Management Board.

Đinh Đại
