Consolidating temporary roads for construction of the 500kV Lao Cai - Vinh Yen transmission line project

Bảo Nguyên - Văn Đức |

Yen Bai - The interspersed soil and rock caused many obstacles in the construction of the 500kV Lao Cai - Vinh Yen transmission line project through Luc Yen district.

In Luc Yen district, Yen Bai province, the 500kV Lao Cai - Vinh Yen transmission line project is 39.55km long, including 82 pole foundation locations with a reclaimed area of 10.97ha; the route passes through 10 communes, with 25 households having to be resettled.

Mr. Hoang Manh Ha - Chairman of Luc Yen District People's Committee - said that the locality has handed over 82 locations to the construction contractor. By June 9, the compensation plan for communes where the project runs through will be completed and submitted for appraisal.

Nhieu vi tri tai huyen Luc Yen, tinh Yen Bai da hoan thanh cong tac ho mong va chuyen sang thi cong dung cot.
Many locations in Luc Yen district, Yen Bai province have completed the foundation work and switched to the construction of pillars. Photo: Minh Nghia

According to Vice Chairman of Yen Bai Provincial People's Committee Ngo Hanh Phuc, to ensure the construction progress according to the direction of the Prime Minister, the implementation of procedures and processes in site clearance is being carried out by the locality in parallel, both completing and completing documents.

In addition, the line passing through Yen Bai province is the longest, with a large workload. Meanwhile, currently, some pole foundation locations in Luc Yen district are facing difficulties in construction due to terrain, geology and weather.

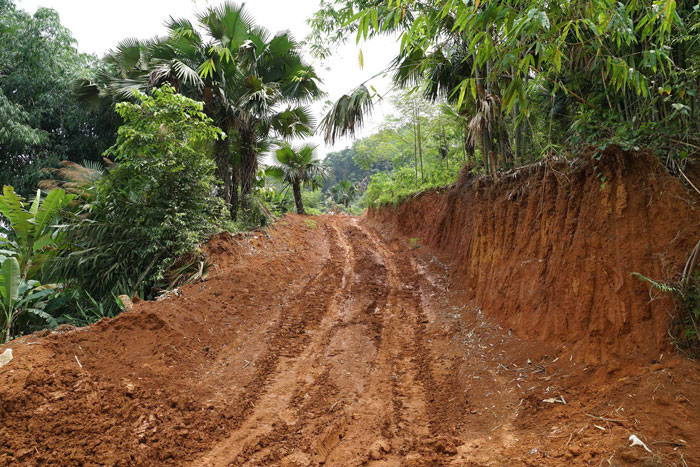

Duong tam vao VT160 co do doc cao, nen dat gap mua de nhao, lun. Nha thau cho biet, ngay ca khi da su dung xich quan banh xe van khong the di chuyen tren duong tam
Some temporary roads have steep slopes, the soil is prone to rain and subsidence, making it impossible for motor vehicles to move. Photo: Minh Nghia

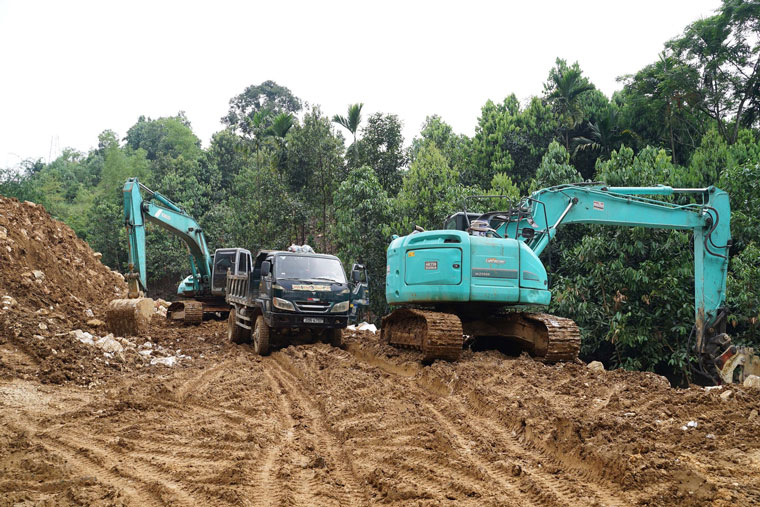

The construction site is narrow, the terrain is steep, forcing the contractor to organize construction in separate holes, while arranging a material warehouse near the foundation to reduce transportation time.

In Lieu Do commune, VT160 has constructed a foundation pit, the remaining three holes are being prepared to pour concrete; VT161 is facing many difficulties due to prolonged heavy rain causing muddy temporary roads, motor vehicles cannot move even though they have wrapped chains and lining the beams to the temporary road; VT159 due to steep terrain, large amount of leveled soil but motor vehicles cannot access it.

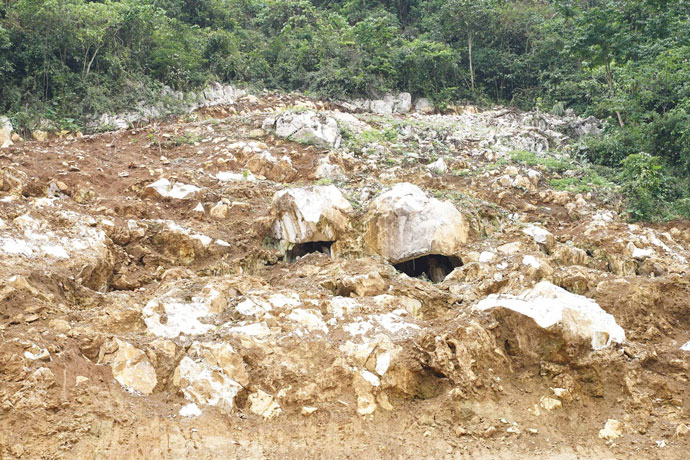

Dia chat dat da xen ket, phia tren la nui da khien qua trinh thi cong gap nhieu tro ngai.
The geology of the land and rocks is interspersed, above which are rocky mountains, causing many obstacles in the construction process. Photo: Minh Nghia

In Vinh Lac commune, VT166 is located on terrain with interspersed rocks on the lower floor and rocky mountains above, posing a high risk of landslides. This is one of the locations with particularly difficult construction conditions, requiring safe and effective foundation treatment and anti-landslide solutions.

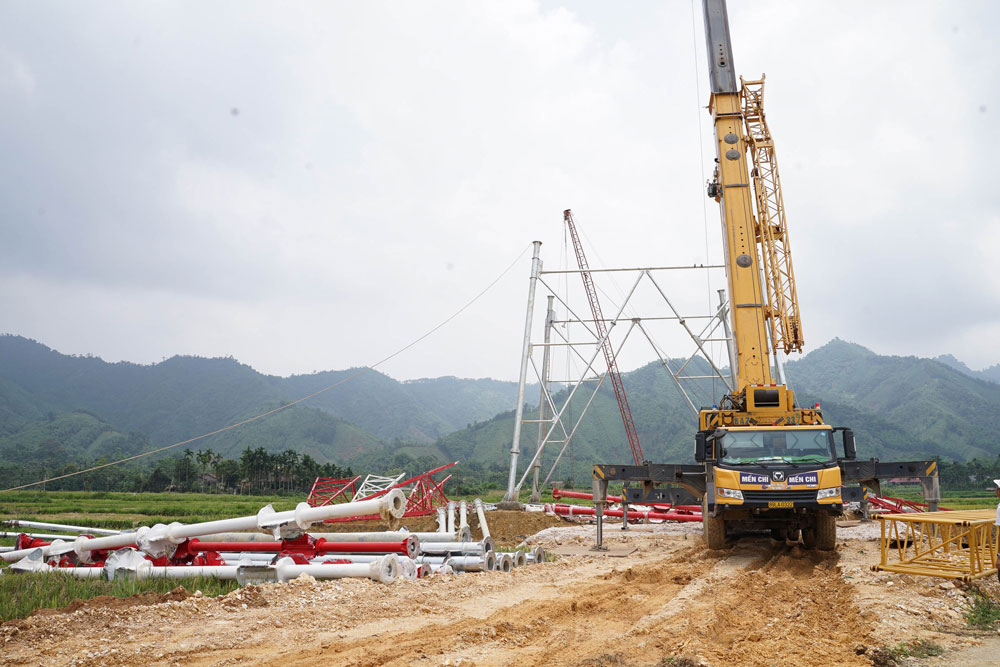

With VT167 - a 72m high, 180-ton steel pole, the construction unit has arranged two teams to work in parallel to shorten the progress.

Tren cong truong, nha thau bo tri may moc day du de san sang thi cong khi troi tanh rao. Anh: Minh Nghia
At the construction site, the contractor arranged adequate machinery to be ready for construction when the weather is fine. Photo: Minh Nghia

It is expected that the pole erection will be completed within the next week, and workers will be arranged to take a day off at the construction site to ensure continuous construction.

On June 6, after inspecting and evaluating locations through Luc Yen district, Chairman of EVN Board of Directors Dang Hoang An requested the Dien 1 Project Management Board and contractors and supervision consultants to arrange additional human resources.

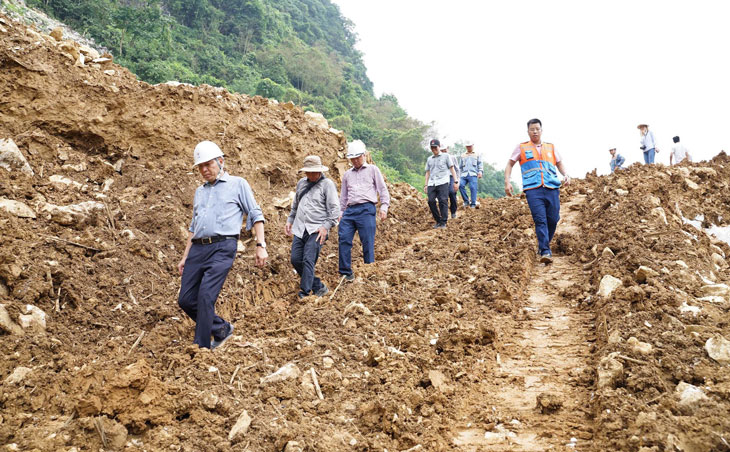

Chu tich HDTV EVN Dang Hoang An (di dau tien) tren duong vao kiem tra vi tri VT166 tai xa Lieu Do, huyen Luc Yen, tinh Yen Bai
EVN Chairman Dang Hoang An (first person) was on his way to check the VT166 location. Photo: Minh Nghia

For locations where temporary roads are under construction with steep slopes, subsided and uneven soil due to rain, Mr. Dang Hoang An requested to take measures to reinforce temporary roads and increase the spread of stones so that mechanical vehicles can access the construction site.

Due to the interstitial geology of soil and rocks, the mountains above are rocky and mountainous, causing many obstacles in the construction process, so the design consultant and the contractor are calculating solutions to ensure safe construction.

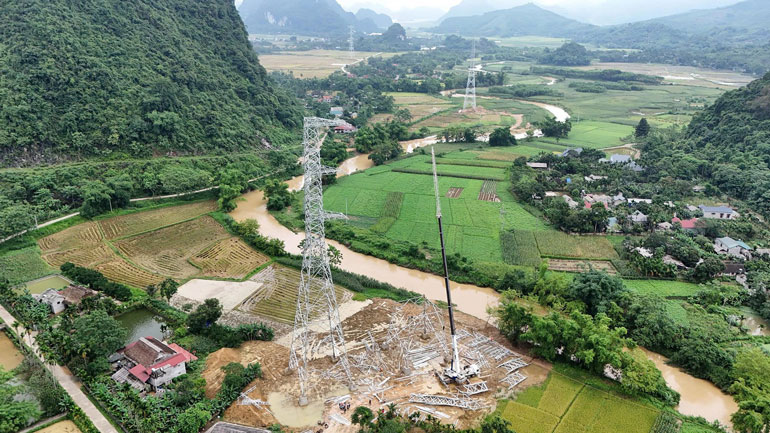

Nhung vi tri co dieu kien mat bang thuan loi dang duoc trien khai lap dung cot ong cao 79m bang cau banh lop can dai.
The locations with favorable site conditions are being accelerated to bring the Lao Cai - Vinh Yen 500kV transmission line project to the finish line on schedule. Photo: Minh Nghia

The 500kV Lao Cai - Vinh Yen transmission line project is about 228.92km long, with a total investment of about VND 7,411 billion. Of which, the project section passing through Yen Bai province is 90.2 km long with 173 pillar foundations.

Bảo Nguyên - Văn Đức
TIN LIÊN QUAN

Concentrating on the 500kV Lao Cai - Vinh Yen line before the storm season

|

Yen Bai - Contractors are taking advantage of the days of working hard, day and night to pour foundations and install steel poles for the Lao Cai - Vinh Yen 500kV Line.

Overnight on the difficult terrain of the Lao Cai - Vinh Yen 500kV transmission line project

|

regardless of day or night, thousands of workers and technical staff are still working hard to ensure the Lao Cai - Vinh Yen 500kV transmission line project reaches the finish line on schedule.

Ceremony next to the giant steel pillars of the 500kV Lao Cai - Vinh Yen line

|

To speed up the progress of the Lao Cai - Vinh Yen 500kV transmission line project, workers worked through the April 30 - May 1 holiday.

Colombian presidential candidate seriously injured

|

Colombian Congressman Miguel Uribe was shot in Bogota while campaigning, with at least one bullet hit his neck or head.

A district headquarters in Ho Chi Minh City will be used as a new ward headquarters

|

HCMC - The current headquarters of District 6 People's Committee will be used as the headquarters of the new Binh Tien Ward People's Committee after the arrangement.

9 Hanoi pho restaurants named by Michelin, the most expensive at 200,000 VND/bowl

|

A series of pho restaurants in Hanoi have just been honored by Michelin Guide in different categories in the 2025 culinary guide.

Russia may continue to retaliate against Ukraine

|

US officials said that Russia has not fully responded to the attack by Ukrainian UAVs, and further retaliations could occur.

The US spends millions of dollars a year to release flies into Panama

|

The campaign to release flies into Panama forests costs $15 million a year, which is believed to be largely funded by the US to control endangered parasites.

Concentrating on the 500kV Lao Cai - Vinh Yen line before the storm season

Văn Đức |

Yen Bai - Contractors are taking advantage of the days of working hard, day and night to pour foundations and install steel poles for the Lao Cai - Vinh Yen 500kV Line.

Overnight on the difficult terrain of the Lao Cai - Vinh Yen 500kV transmission line project

Bảo Nguyên |

regardless of day or night, thousands of workers and technical staff are still working hard to ensure the Lao Cai - Vinh Yen 500kV transmission line project reaches the finish line on schedule.

Ceremony next to the giant steel pillars of the 500kV Lao Cai - Vinh Yen line

Bảo Nguyên |

To speed up the progress of the Lao Cai - Vinh Yen 500kV transmission line project, workers worked through the April 30 - May 1 holiday.
