In 2025, the total capital allocated to the Provincial Traffic Construction Investment Project Management Board ( prizes) is more than VND 2,940 billion. (excluding the capital of the 5 Project Management Boards of the area that have just received).
Of which, public investment capital for the year is nearly 1,390 billion VND, extended capital from last year to this year is nearly 990 billion VND and additional capital allocated outside the plan is nearly 480 billion VND. To date, the disbursement has reached nearly 700 billion VND, equivalent to nearly 23% of the plan.

According to the report of the Provincial Traffic Construction Investment Project Management Board, since the beginning of the year, the unit has completed 3 projects, including: Phuoc Loc Bridge (Tra Khuc 3), Ben Dinh Port breakwater (special to Ly Son area) and Lien Hiep I resettlement area (expanded).
At the same time, focus on removing obstacles and speeding up progress to bring many large projects to the finish line, including: Tra Khuc River downstream dam, reservoir, anti-landslide embankment projects combined with land fund development, emergency embankment. Remove obstacles to finalize the completion of 3 projects.
The group of transitional projects to be completed after 2025 are being focused on by investors to remove obstacles and speed up progress, such as: Hoang Sa - Doc Soi Road, Dung Quat - Sa Huynh coastal road, the road connecting Thach Bich bridge to Tinh Phong, the embankment to prevent landslides and restore the landscape of the southern bank of Tra Khuc river...

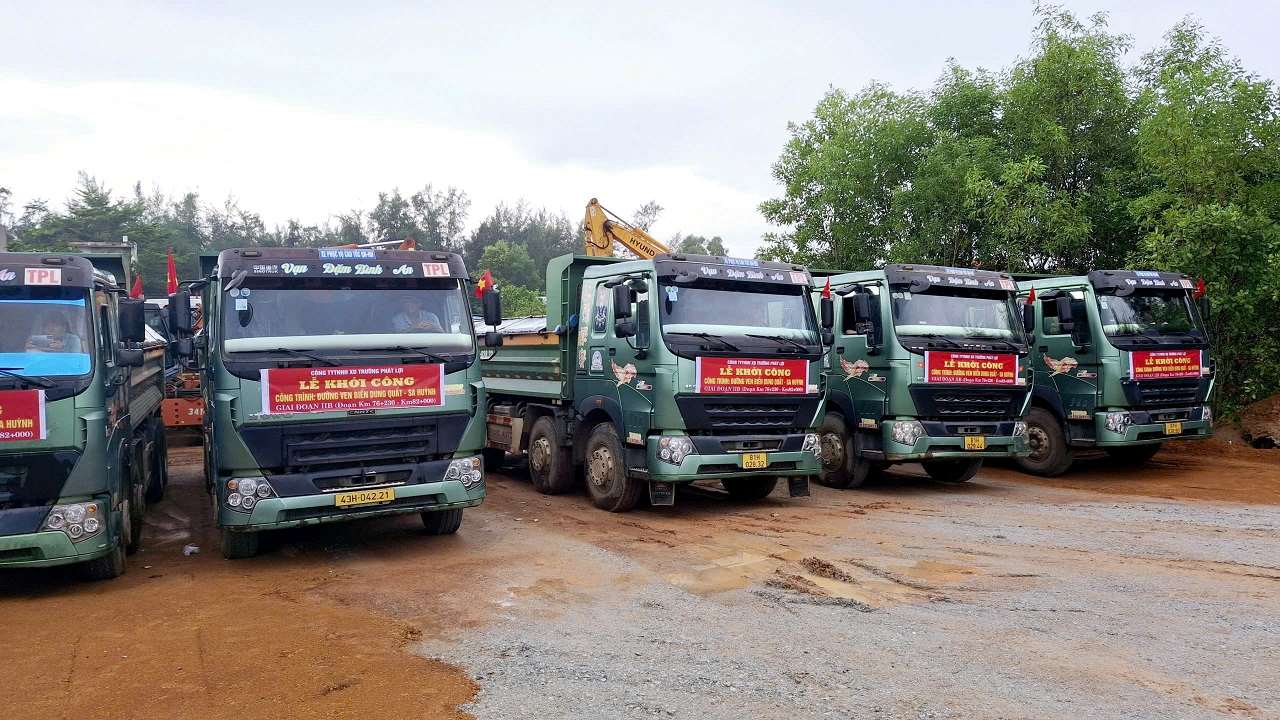

Since the beginning of the year, the unit has started 4 new projects with a total investment of nearly 200 billion VND, including: Dung Quat - Sa Huynh coastal road (km76-82); upgrading and expanding the Suoi Kinh drainage system, serving to prevent flooding in VSIP industrial park; two emergency embankment projects to prevent landslides: An Phu and Sa Can gate.
According to Mr. Tran Hoang Vinh - Director of the Quang Ngai Province Traffic Construction Investment Project Management Board, from now until the end of the year, the unit will speed up investment preparation procedures, select contractors and start construction of 3 projects with a total investment of more than VND 2,600 billion, including: Tra Khuc 1 Bridge; Dung Quat Economic Zone Infrastructure Upgrade and Expansion Project; Tuyen Tung Reservoir Irrigation and Expansion Project.
In addition, complete procedures to start a series of new projects with a total investment of thousands of billions of VND in 2026, including: Upgrading and renovating National Highway 24B (km23 - Km29); Dung Quat - Sa Huynh coastal road, phase III; Bridge and road DT.623B (Thach Nham bridge); Road connecting from National Highway 1 (intersection of Da Nang - Quang Ngai expressway) to the Dung Quat - Sa Huynh coastal road.
According to Mr. Tran Hoang Vinh, the unit strives to disburse 100% of the annual capital plan on schedule. To achieve the above goal, the Management Board requested departments and branches to increase support, the Provincial Land Fund Development Center and the authorities of communes and wards in the project area to actively coordinate and effectively carry out site clearance work to serve the projects.
