Hoa Binh Hydropower Plant expands to be ready to operate, contributing 480MW to the national grid

Hải Đăng |

Phu Tho - The Hoa Binh Hydropower Plant Expansion Project has completed construction and is ready to generate electricity to generating generators No. 1 on August 19.

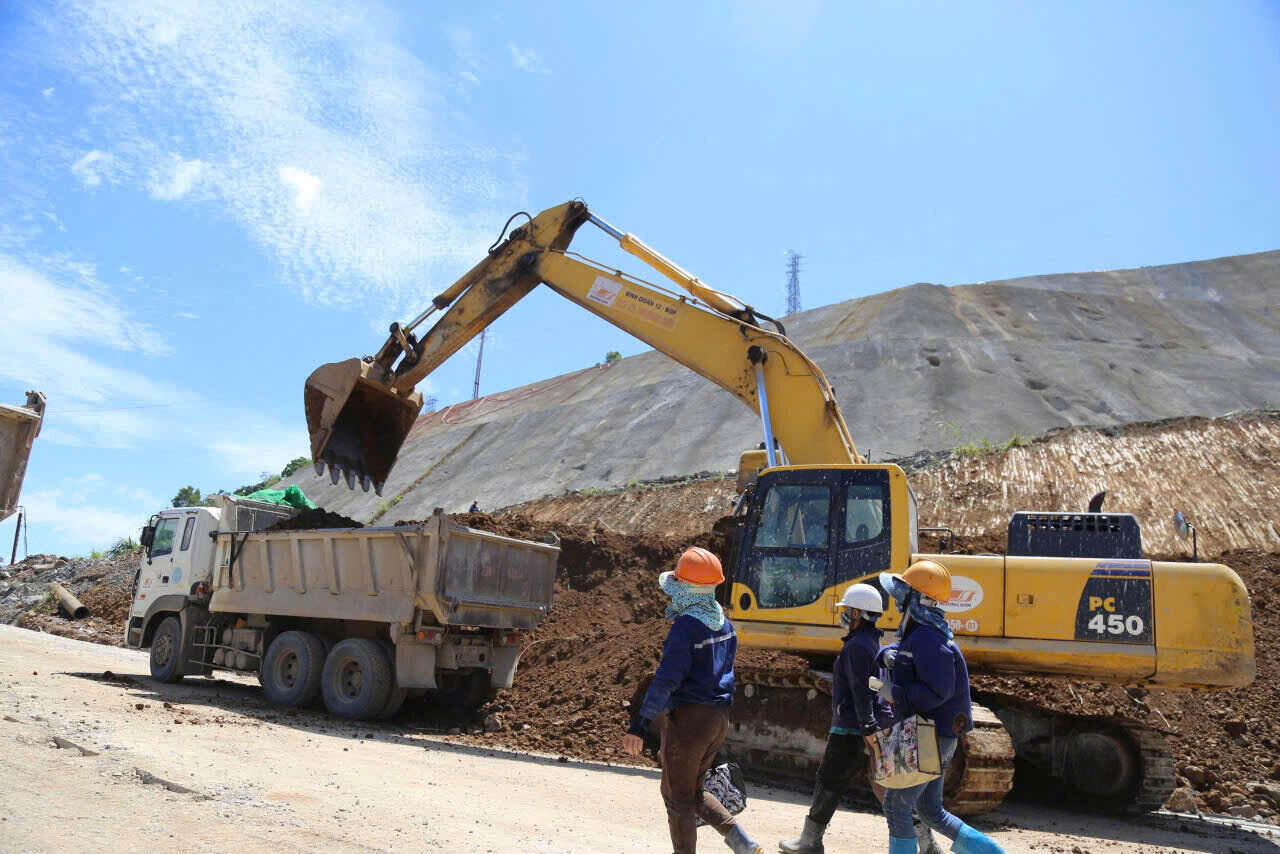

In August, the reporter noted at the expanded Hoa Binh Hydropower Plant, modern vehicles and machinery are operating continuously, coordinated smoothly with progress.

The project was built on the right side of the existing dam, independent of the items of the old factory.

Tren cong truong Thuy dien Hoa Binh mo rong, phuong tien, may moc hien dai hoat dong lien tuc, duoc dieu phoi nhip nhang, dam bao tien do. Anh: Le Chung
At the expanded Hoa Binh Hydropower Plant, modern vehicles and machinery are operating continuously, coordinated smoothly, ensuring progress. Photo: Le Chung

After more than 4 years of continuous construction, all items serving the supply of water for the energy route have been completed and are ready for trial operation.

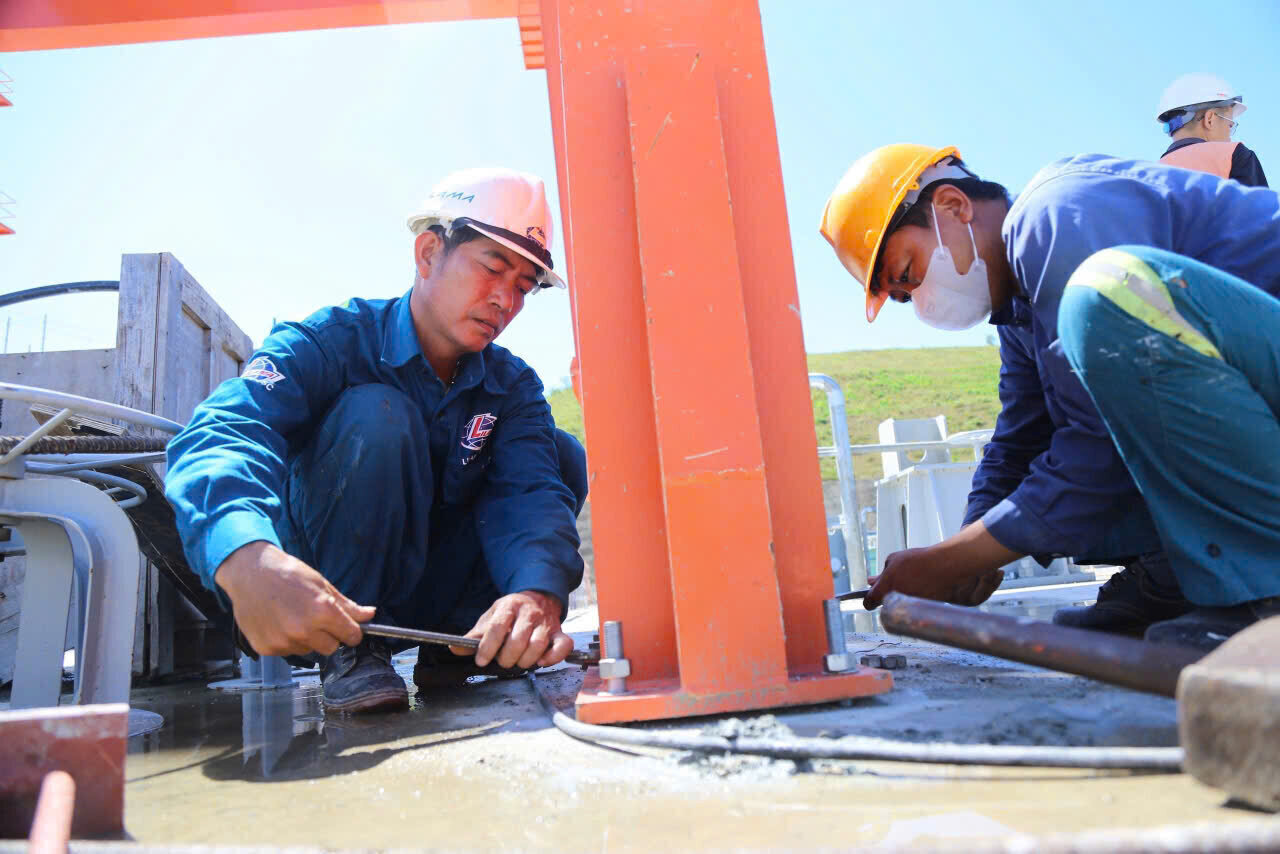

Engineer Truong Cong Hung (contractor LILAMA 10) said: "The teams work in shifts, strictly comply with safety regulations, and do not have serious work accidents".

Cac to doi, cong nhan lam viec theo ca kip, tuan thu nghiem quy dinh an toan lao dong. Anh: Le Chung
Teams and workers work in shifts, strictly complying with labor safety regulations. Photo: Le Chung

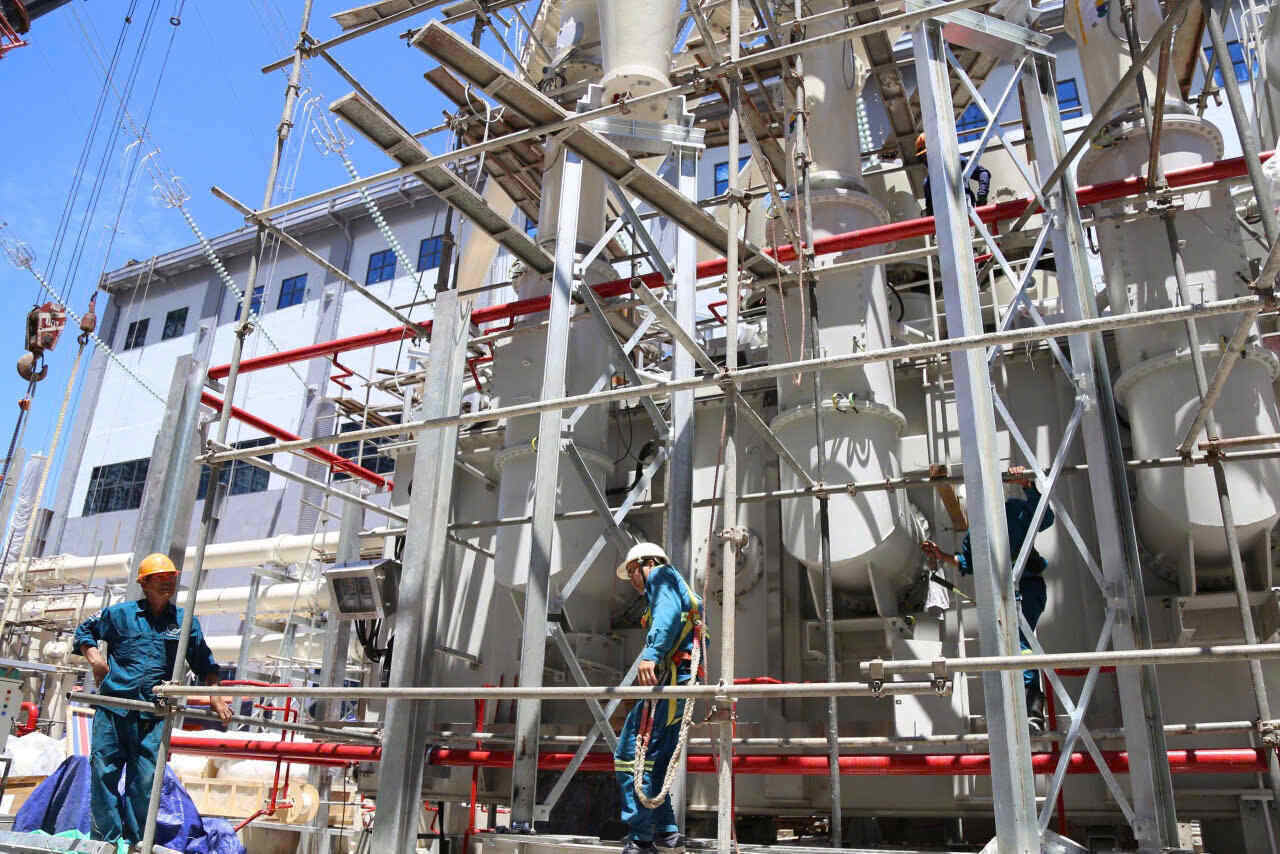

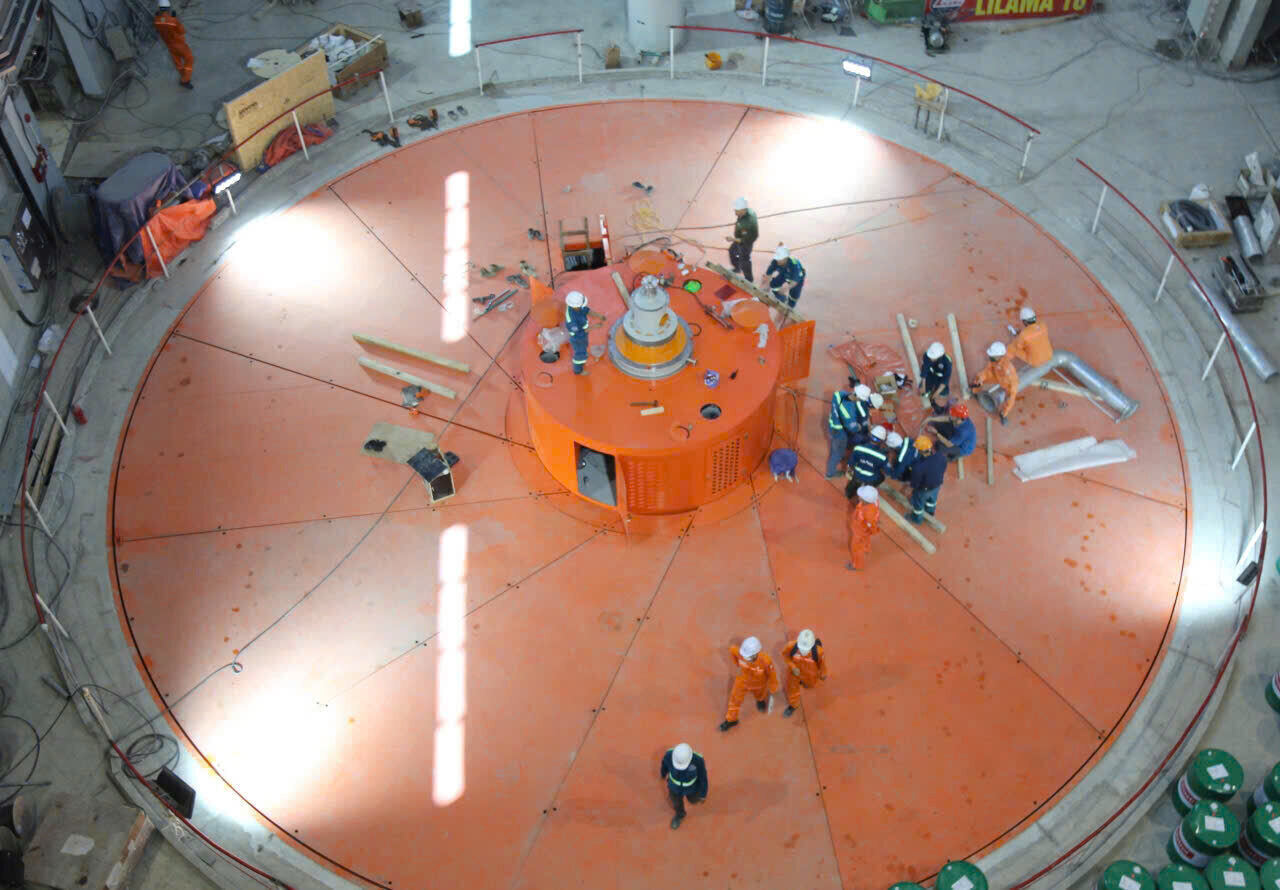

According to the Power Project Management Board 1 (EVNPMB1) - the investor's representative unit managing the project, the No. 1 equipment team has completed the installation of Francis vertical turbines, generators, acceleration systems, 500kV transformers and auxiliary systems.

The voltage, GIS, and IPB items are all in the experimental and validation phase. The No. 2 group of machines has also reached about 90% of the installed volume.

Nha thau tiep tuc hoan thien khu vuc to may. Anh: Le Chung
The contractor continues to complete the construction site area. Photo: Le Chung

The main items such as water intake gates, vertical wells, underpasses - water drainage tunnels, hydropower plants and discharge channels have been basically completed.

The water intake is reinforced concrete to a height of 122.5m, installed with garbage barriers, valve doors, axle bridges and auxiliary equipment. The water pipeline system is about 800m long, 11m in diameter and has been reinforced, steel plated and wrapped, ensuring the design flow.

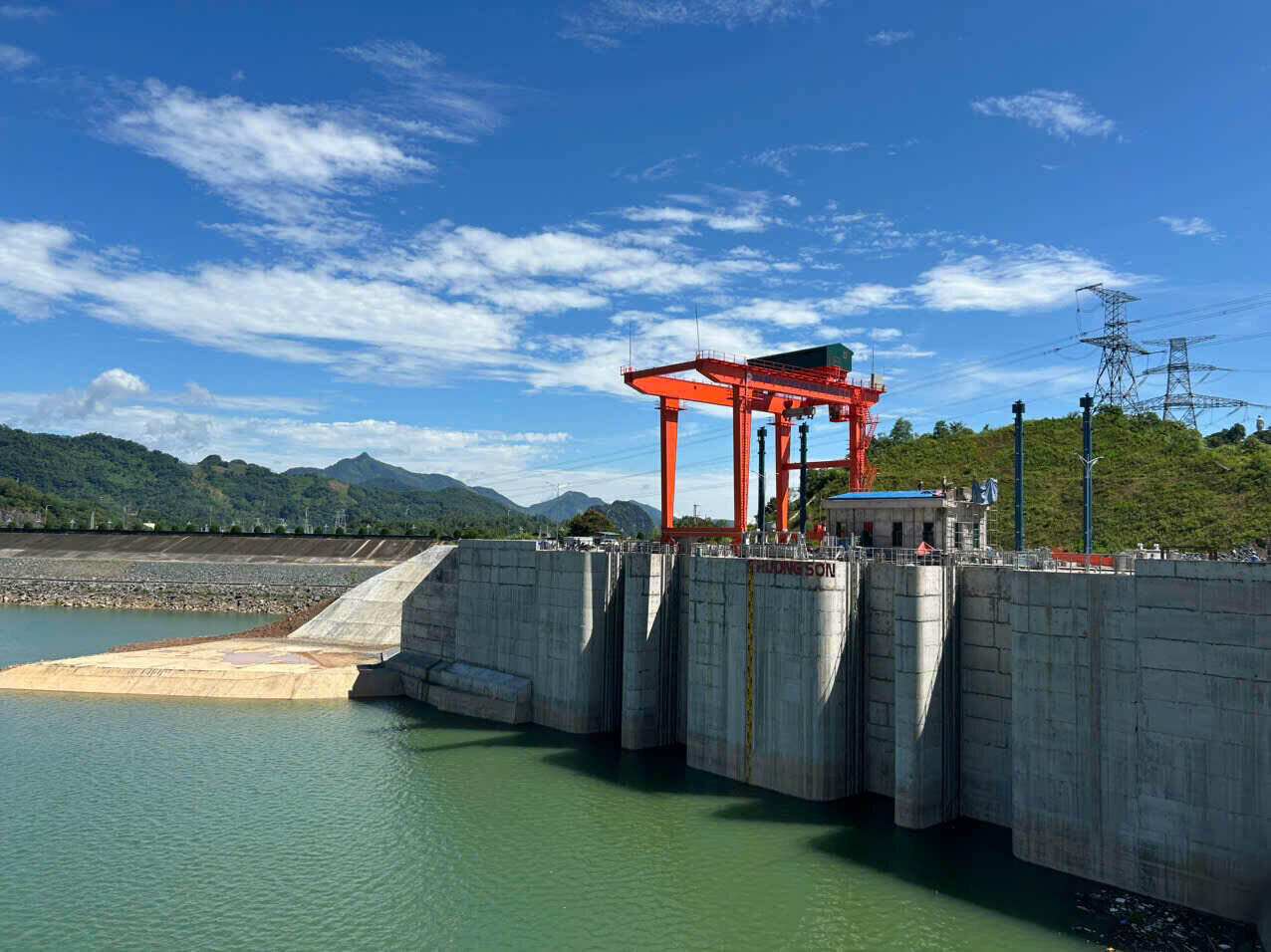

Cua lay nuoc cua Thuy dien Hoa Binh mo rong da hoan thanh thi cong. Anh: Le Chung
The water intake of the expanded Hoa Binh Hydropower Plant has been completed. Photo: Le Chung

All materials and equipment are strictly inspected from factory, transportation to installation. The results of observation and comparison testing showed that the project was stable, with no signs of abnormality.

The blasting process of tunnel excavation is closely monitored, the parameters always fluctuate below the permitted limit, ensuring safety for existing works and the environment.

Khu duong day vao nha may thuy dien dang duoc hoan thien. Anh: Le Chung
The area of the line to the hydropower plant is being completed. Photo: Le Chung

Mr. Bui Phuong Nam, Director of the Power 1 Project Management Board, said: The unit has mobilized maximum human resources and equipment, applied flexible technical measures to ensure both progress and maintained quality and safety.

The spirit is not to back down in the face of any difficulties, to complete the power generation goal on time.

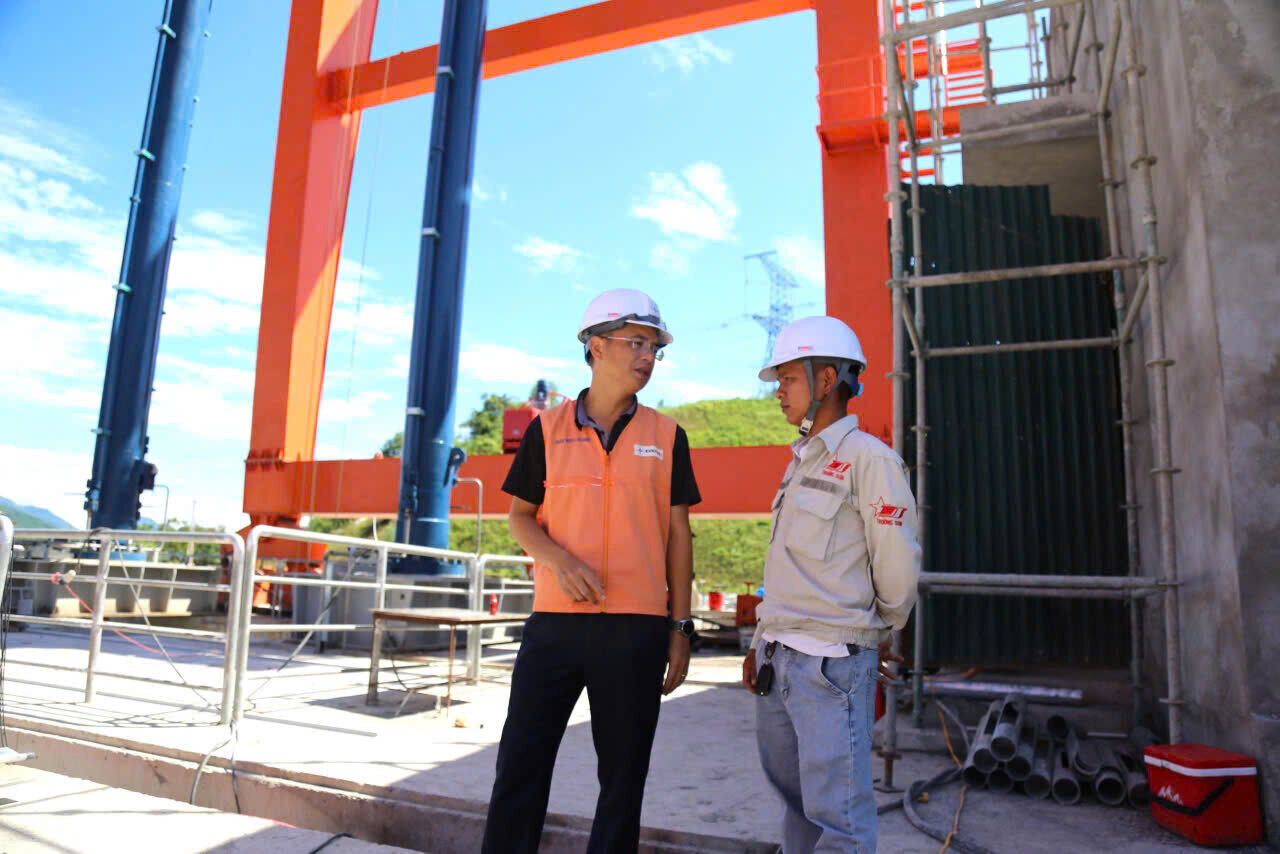

Can bo, cong nhan dang trao doi giai phap ky thuat. Anh: Le Chung
Officers and engineers are discussing technical solutions. Photo: Le Chung.

When completed, the project will add about 480MW to the national power system, improve water regulation capability, and reduce operational pressure for the old plant.

The representative of the project management investor also said that after the energy line is recharged, it is expected that the No. 1 plant will be tested and commercialally generated on the occasion of the 80th anniversary of the August Revolution.

Plant No. 2 is expected to complete power generation in December 2025. Some auxiliary items will be deployed after the flood season but will not affect operations.

The Hoa Binh Hydropower Plant expansion project was approved by Prime Minister Chinh Phu in Decision No. 389/TTg-CN dated April 11, 2018, with a total investment of VND 9,220 billion, with a scale of 2 generators, total capacity of 480MW.

This is a national key project, not only in terms of economy and technology, but also has special political significance when associated with the historical milestone of the country.

Hải Đăng
RELATED NEWS

Order to close 2 consecutive bottom spillways of Hoa Binh hydroelectric reservoir, 6 provinces and cities must ensure safety

|

The Ministry of Agriculture and Environment has just issued a telegram on closing the bottom spillway of Hoa Binh Lake.

Order to open another bottom spillway gate of Hoa Binh hydroelectric reservoir this afternoon

|

Another bottom spillway of Hoa Binh hydroelectric reservoir was ordered to open this afternoon.

At the foot of Hoa Binh hydropower plant in dry season

|

Hoa Binh - The water level of Hoa Binh Lake has dropped sharply, revealing many bare rock fields. Cage fish farmers proactively adapt to limit damage during the prolonged dry season.

National Highway 91 in Can Tho has a surplus of more than VND3,000 billion: Reviewing and determining the cost of site clearance

|

Can Tho - The investor is coordinating with relevant units to conduct a review to determine the cost of site clearance (GPMB) of the project.

Young man throws 20-liter water bottle from the 26th floor of an apartment building in Ho Chi Minh City to the ground

|

HCMC - On August 14, social networks spread a clip recording the scene of many 20-liter water bottles falling from the upper floors of an apartment building, endangering people.

Hanoi has heavy rain, people leave their meals unused and run away from flooding

|

Hanoi - The heavy rain at noon on August 14 quickly turned Truong Dinh street into a river, in some places flooding nearly 30cm deep.

SJC gold bar price increases sharply, reaching a peak of 125 million VND/tael

|

After many sessions of struggling at a narrow range, the price of gold bars this morning (August 14) was unexpectedly adjusted by some businesses to increase sharply to 800,000 VND/tael.

28 enterprises will be honored as "Outstanding Enterprises for Workers"

|

The "Outstanding Enterprise for Workers" Award is scheduled to take place at 7:30 p.m. on August 15.

Order to close 2 consecutive bottom spillways of Hoa Binh hydroelectric reservoir, 6 provinces and cities must ensure safety

Huy Hùng |

The Ministry of Agriculture and Environment has just issued a telegram on closing the bottom spillway of Hoa Binh Lake.

Order to open another bottom spillway gate of Hoa Binh hydroelectric reservoir this afternoon

Huy Hùng |

Another bottom spillway of Hoa Binh hydroelectric reservoir was ordered to open this afternoon.

At the foot of Hoa Binh hydropower plant in dry season

Đặng Tình - Nguyễn Trường |

Hoa Binh - The water level of Hoa Binh Lake has dropped sharply, revealing many bare rock fields. Cage fish farmers proactively adapt to limit damage during the prolonged dry season.
