Inside the nearly 4 trillion VND hydropower project in Dong Nai, expected to generate electricity in 2027

HÀ ANH CHIẾN |

Dong Nai - The Tri An Hydropower Plant project (Tri An ward) expansion with a capacity of 200MW will generate electricity from both units in 2027.

On August 22, Lao Dong Newspaper reporters recorded the actual progress of construction of the Tri An Hydropower Plant expansion project in Tri An ward, Dong Nai city, invested by Vietnam Electricity Group (EVN), with a total investment of 3,965 billion VND.

The construction project of Tri An Hydropower Plant expansion is a special-class construction project, approved for investment policy by the People's Committee of Dong Nai province (now the People's Committee of Dong Nai city) in 2020.

The plant has an installed capacity of 200 MW, including 2 units, each unit 100 MW. This is an important project to increase the ability to generate peak coverage capacity for the national power system, effectively exploit the annual surplus water discharged during the flood season of the existing Tri An Hydropower Plant to generate electricity, and at the same time improve the ability to regulate frequency and stabilize the national power system frequency.

Overview of the construction of the Tri An Hydropower Plant expansion project in Tri An ward, Dong Nai city:

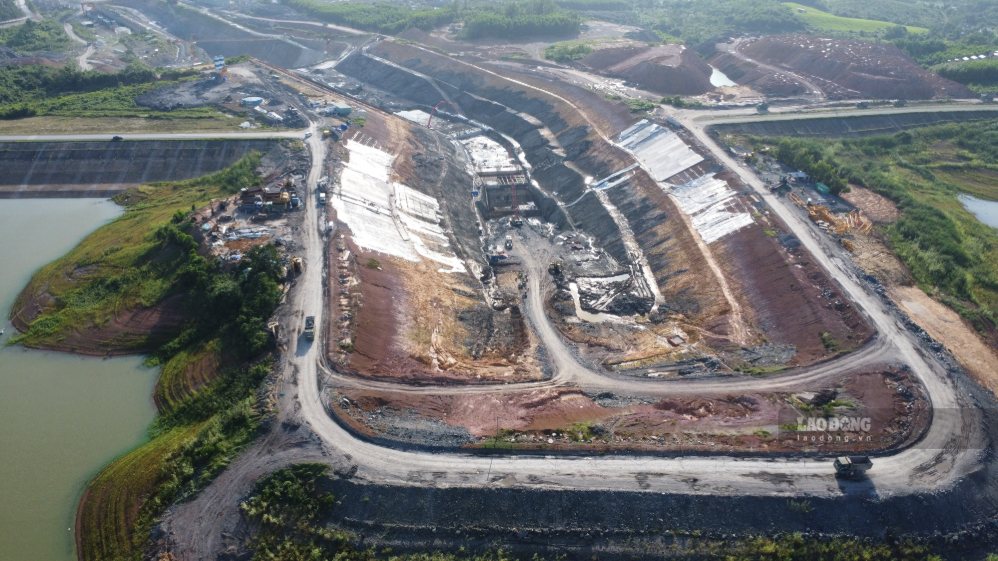

Theo Ban Quản lý dự án Điện 3 (thuộc EVN), đại diện chủ đầu tư quản lý, điều hành dự án cho biết: Dự án xây dựng mới tuyến năng lượng gồm: Kênh dẫn vào cửa nhận nước, cửa nhận nước, đường ống áp lực, nhà máy thủy điện, kênh xả hạ lưu và hệ thống đấu nối nhà máy với hệ thống điện Quốc gia (đường dây đấu nối Nhà máy thủy điện Trị An mở rộng vào trạm biến áp 220/110kV của Nhà máy thủy điện Trị An hiện hữu). Ảnh: HAC
According to the Power Project Management Board 3 (under EVN), representative of the investor managing and operating the project: The project to build a new energy line includes: Canals leading to water intake gates, water intake gates, pressure pipelines, hydropower plants, downstream discharge channels and the plant's connection system with the national power system (extended Tri An Hydropower Plant connection line to the 220/110kV substation of the existing Tri An Hydropower Plant). Photo: HAC

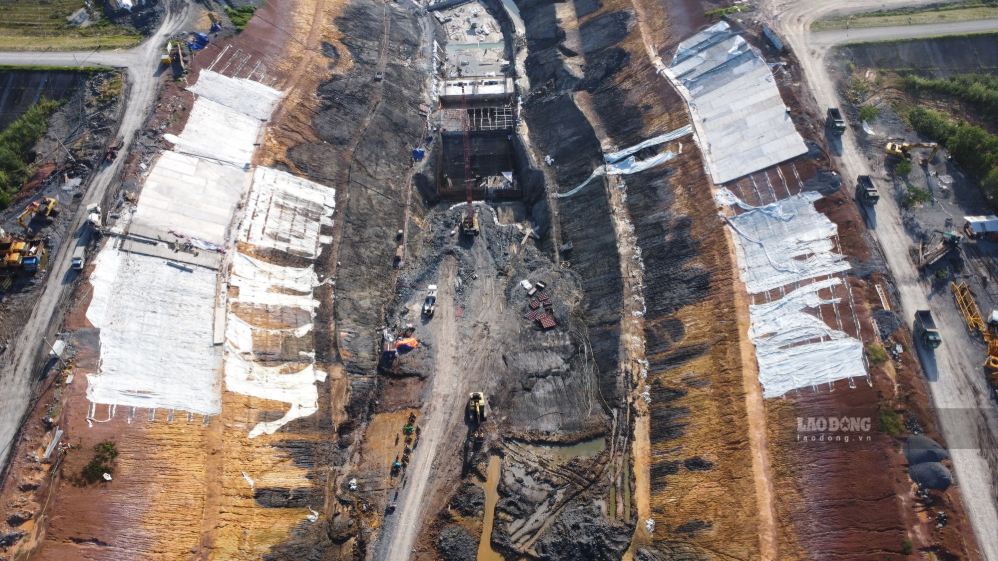

Dự án sử dụng chung các hạng mục công trình của Nhà máy thủy điện Trị An hiện hữu gồm: Hồ chứa, đập chính, các đập phụ, đập tràn, đường vận hành, trạm phân phối. Ảnh: HAC
The project uses common items of the existing Tri An Hydropower Plant including: reservoir, main dam, auxiliary dams, spillway, operating road, distribution station. Photo: HAC

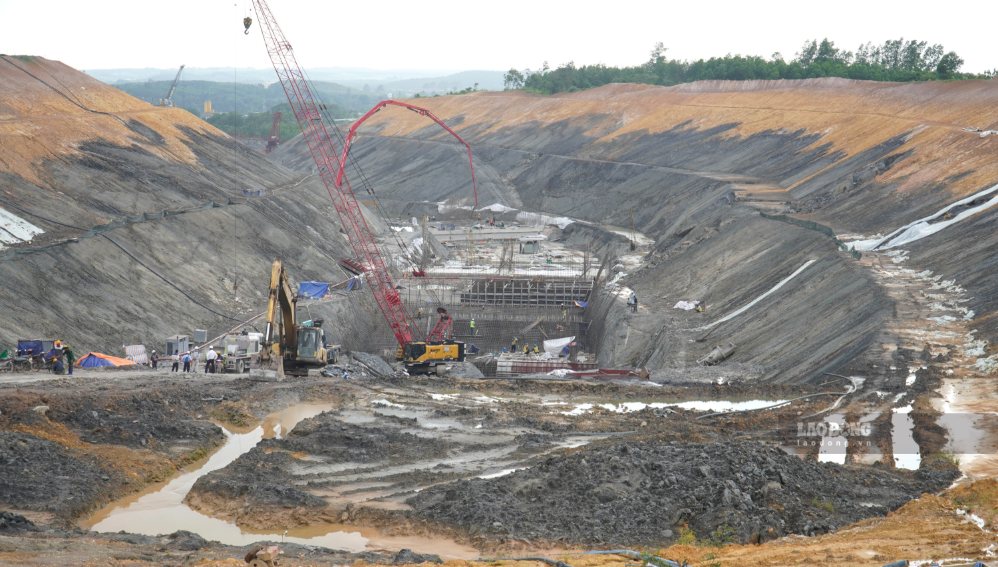

Về mặt bằng, toàn bộ 92,09 ha/192 thửa đất đã hoàn thành bàn giao, các hộ thuộc diện tái định cư đã được bố trí. Ảnh: HAC
In terms of land, the entire 92.09 ha/192 land plots have been completed and handed over, and resettlement households have been arranged. Photo: HAC

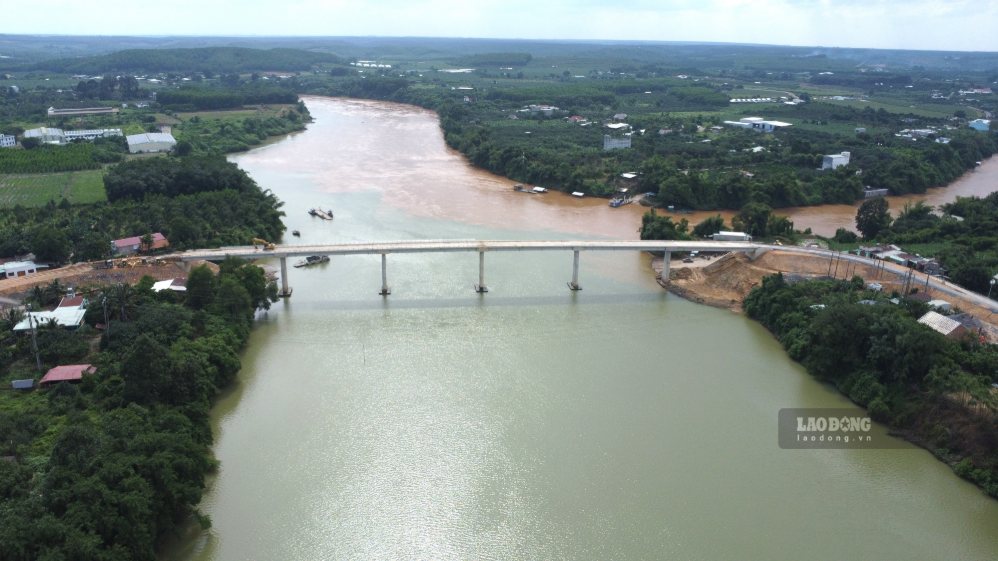

Về tiến độ, gói thầu thi công cầu Hiếu Liêm đã hoàn thành phần kết cấu chính. Ảnh: HAC
Regarding progress, the Hieu Liem bridge construction package has completed the main structure. Photo: HAC

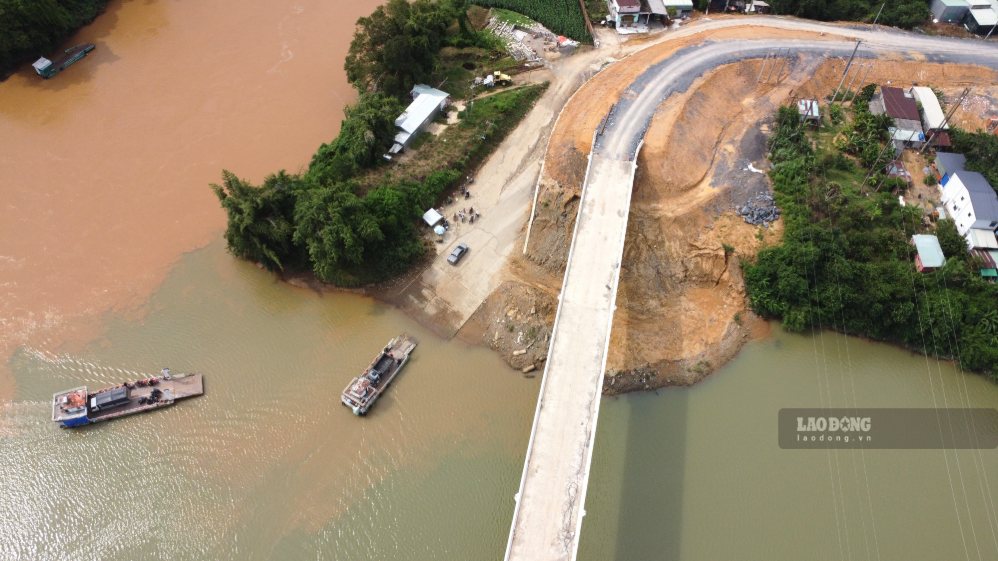

Hạng mục này đang hoàn thiện đường dẫn hai đầu cầu, dự kiến nghiệm thu đưa vào sử dụng vào tháng 9.2026. Ảnh: HAC
This item is completing access roads at both ends of the bridge, expected to be accepted and put into use in September 2026. Photo: HAC
Gói thầu thi công công trình chính, liên danh nhà thầu đang thi công đồng bộ nhiều mũi, tất cả các hạng mục công trình đang thực hiện công tác đào đắp, bê tông. Ảnh: HAC
For the main construction package, the contractor consortium is synchronously constructing many fronts, all project items are undergoing excavation and embankment, and concrete. Photo: HAC

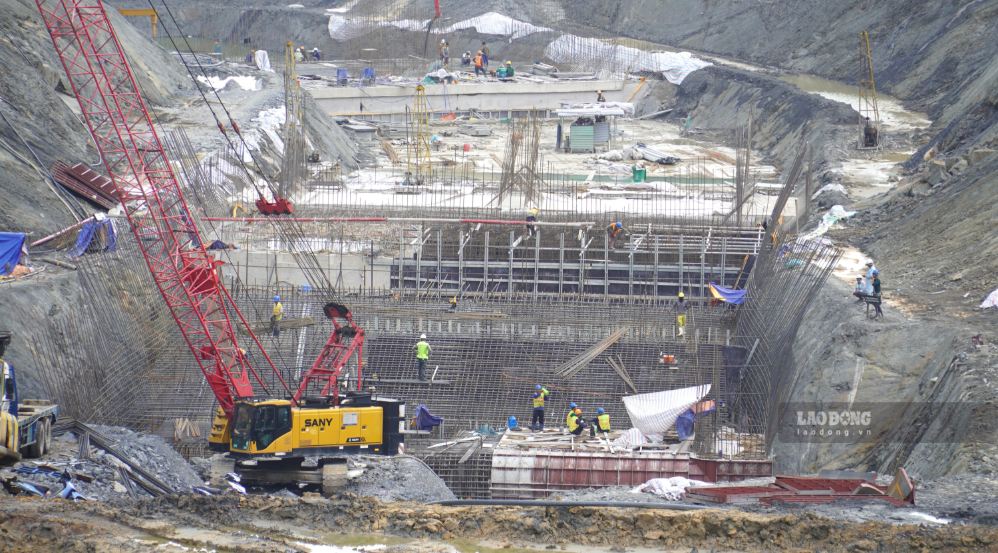

Khối lượng đào lũy kế đạt 2,53/3,27 triệu m3 (77,4%), Công tác bê tông cho các hạng mục cửa lấy nước, đường ống áp lực và nhà máy khối lượng bê tông luỹ kế 8.976/143.323 m3 (6,4%), đang triển khai lắp đặt thiết bị quan trắc… Ảnh: HAC
Accumulated excavation volume reached 2.53/3.27 million m3 (77.4%). Concrete work for water intake gates, pressure pipelines and factories, accumulated concrete volume 8,976/143,323 m3 (6.4%), monitoring equipment is being installed... Photo: HAC

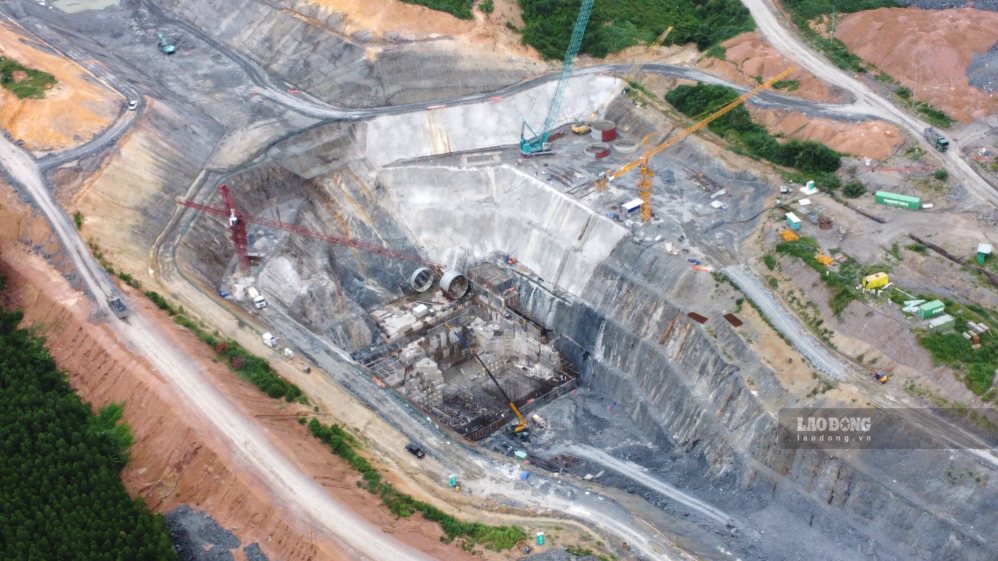

Dự án được khởi công trong năm 2025 và dự kiến phát điện tổ máy số 1 vào quý III/2027, phát điện tổ máy số 2 vào quý IV/2027 và hoàn thành toàn bộ công trình trong quý IV/2027. Ảnh: HAC
The project was started in 2025 and is expected to generate electricity from unit No. 1 in the third quarter of 2027, unit No. 2 in the fourth quarter of 2027 and complete the entire project in the fourth quarter of 2027. Photo: HAC

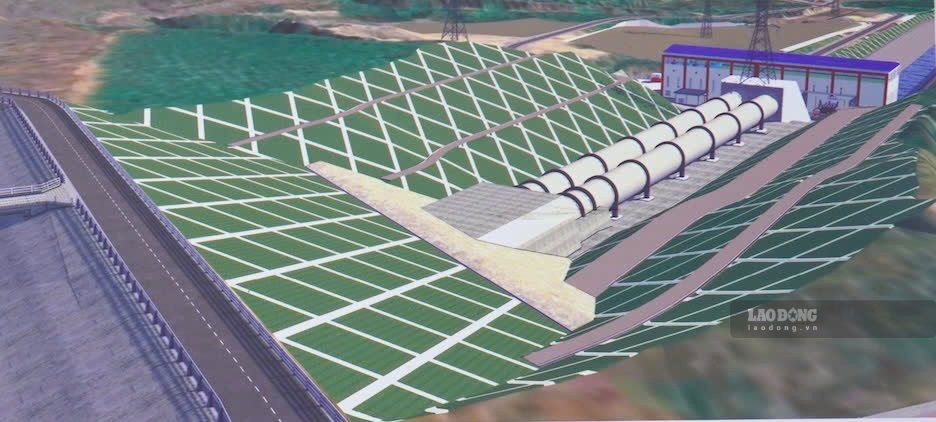

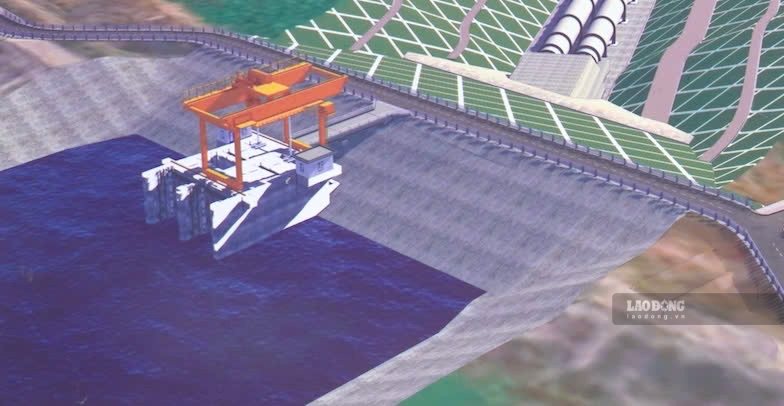

Phối cảnh Nhà máy thủy điện Trị An mở rộng. Ảnh: HAC
Perspective of Tri An Hydropower Plant expansion. Photo: HAC
Phối cảnh Nhà máy thủy điện Trị An mở rộng. Ảnh: HAC
Perspective of Tri An Hydropower Plant expansion. Photo: HAC

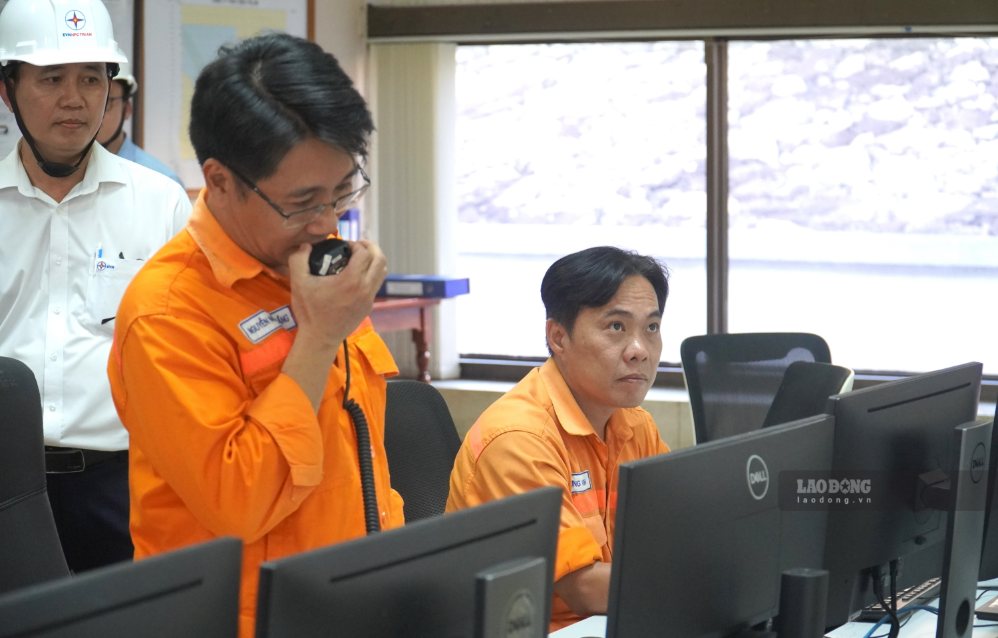

Bên cạnh đó, Nhà máy thủy điện Trị An hiện hữu đang hoạt động có 4 tổ máy, tổng công suất thiết kế 400MW, là thủy điện lớn nhất miền Nam. Ảnh: HAC
In addition, the existing Tri An Hydropower Plant is operating with 4 units, a total designed capacity of 400MW, and is the largest hydropower plant in the South. Photo: HAC

Progress of the Tri An Hydropower Plant expansion project:

Construction:

Canal completion in August 2027.

Complete water intake and compensation block in October 2027.

Complete pressure pipeline in June 2027.

Factory completion in September 2027.

Completing the discharge channel in June 2027.

Installing equipment:

Installing cranks and levers of Unit 1 and 2 in October 2026 - December 2026.

Installing the locomotive shaft bridge in March 2027.

Turbine compartment of unit 1 and 2 January 2027 - April 2027.

Turbine, generating unit 1 July 2027 - October 2027.

Transformer unit 1 May 2027 - July 2027.

Experiment, power generation of Unit 1 October 2027 - December 2027.

Turbine, generating unit 2 September 2027 - November 2027.

Transformer unit 2 June 2027 - August 2027.

Testing and generating electricity for unit 2 in November 2027 - December 2027.

HÀ ANH CHIẾN
RELATED NEWS

Complete the Tri An Hydropower Plant expansion project in Q4/2027

|

Dong Nai - Vice President of Vietnam General Confederation of Labor Thai Thu Xuong visits and presents gifts to union members and workers constructing the Tri An Hydropower Plant expansion project.

Launching emulation to accelerate the progress of the Tri An Hydropower project expansion

|

Dong Nai - Vice President of Vietnam General Confederation of Labor Phan Van Anh attends the launching ceremony of emulation to complete the goals and progress of the Tri An Hydropower Plant expansion project in 2026.

Tri An Hydropower Plant Project to Expand Nearly VND4,000 Billion is stuck in site clearance

|

Dong Nai - The Tri An Hydropower Plant expansion project is invested by EVN, with a total investment of nearly 4,000 billion VND, expected to be completed by the end of 2027.

Starting construction of Tri An hydropower plant to expand capacity to 200MW, total investment of VND 3,900 billion

|

Dong Nai - Tri An Hydropower Plant has an expanded capacity of 200MW, with an average annual electricity output of about 200 million kWh.

Nearly 1,000 officials and soldiers in Lang Son help people cope with floods

|

Lang Son - The provincial armed forces have mobilized nearly 1,000 officers and soldiers to evacuate nearly 100 households and move property to safe places during floods.

Chairman of Nha Trang ward directs inspection of the case of an elderly woman kneeling in the middle of the road

|

Khanh Hoa - The Chairman of Nha Trang Ward has assigned the Police to inspect the case of an elderly woman kneeling in the middle of the road, begging after a traffic collision.

Hanoi announces 58 working headquarters and production facilities subject to relocation

|

Hanoi - There are 58 facilities subject to relocation due to inconsistency with the Overall Plan of the Capital, urban and rural planning in the city.

Buying and selling, creating artificial scarcity is pushing house prices up

|

According to the Minister of Construction, the shortage of commercial housing in the mid- and low segments leads to speculation, buying and selling, pushing house prices up.

Complete the Tri An Hydropower Plant expansion project in Q4/2027

HÀ ANH CHIẾN |

Dong Nai - Vice President of Vietnam General Confederation of Labor Thai Thu Xuong visits and presents gifts to union members and workers constructing the Tri An Hydropower Plant expansion project.

Launching emulation to accelerate the progress of the Tri An Hydropower project expansion

HÀ ANH CHIẾN |

Dong Nai - Vice President of Vietnam General Confederation of Labor Phan Van Anh attends the launching ceremony of emulation to complete the goals and progress of the Tri An Hydropower Plant expansion project in 2026.

Tri An Hydropower Plant Project to Expand Nearly VND4,000 Billion is stuck in site clearance

HÀ ANH CHIẾN |

Dong Nai - The Tri An Hydropower Plant expansion project is invested by EVN, with a total investment of nearly 4,000 billion VND, expected to be completed by the end of 2027.

Starting construction of Tri An hydropower plant to expand capacity to 200MW, total investment of VND 3,900 billion

Hà Anh Chiến |

Dong Nai - Tri An Hydropower Plant has an expanded capacity of 200MW, with an average annual electricity output of about 200 million kWh.
