500kV Lao Cai - Vinh Yen transformer station accelerates in time for the grid leveling day

Đinh Đại |

In the summer of August, the construction site of the Lao Cai - Vinh Yen 500kV Line project was still bustling with construction and construction to bring the project to the finish line on time.

The 500kV Lao Cai - Vinh Yen Line project has a total investment of more than VND 7,410 billion, a total length of about 229.5km passing through 31 communes in Lao Cai and Phu Tho provinces, with a total of 468 electric pole foundation locations. The project affects 2,189 households, of which 213 households must be resettled.

In Lao Cai province, after more than 5 months of construction, the 500kV Transformer Station item, an extremely important link, has been being accelerated.

500kV transformer stations play an important role in the power transmission system, with the main function of converting electricity to transmit electricity far away with high efficiency and distributing electricity to consumption areas.

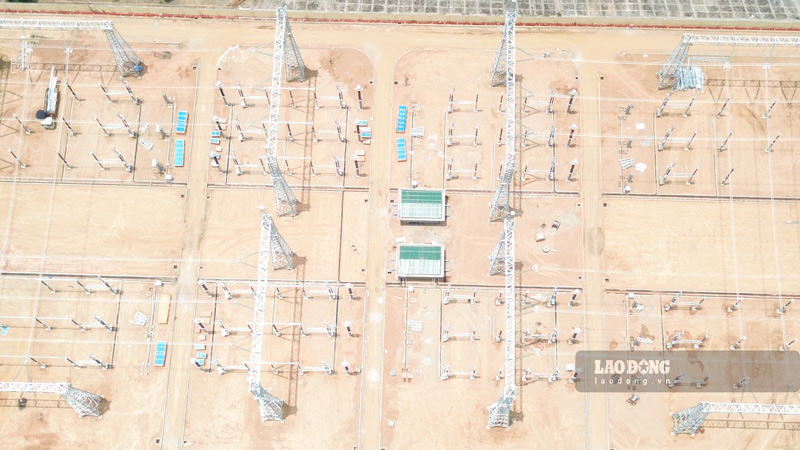

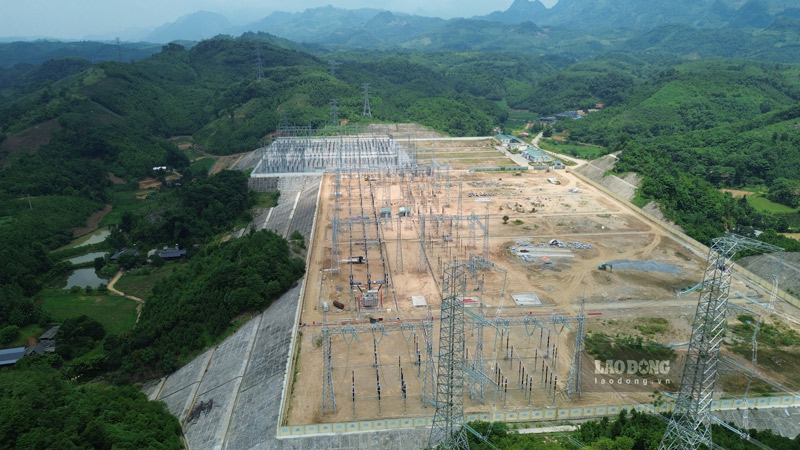

Toan canh Tram bien ap 500kv Lao Cai - Vinh Yen sap dua vao su dung. Anh: Dinh Dai

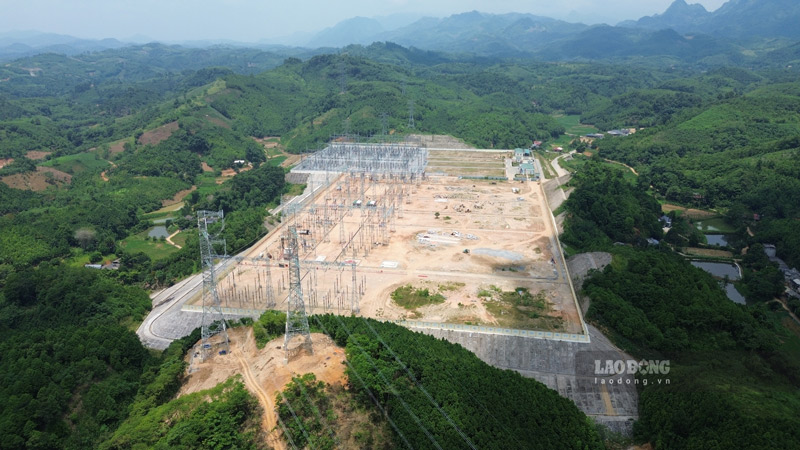

Overview of the Lao Cai - Vinh Yen 500kV Transformer Station about to be put into use. Photo: Dinh Dai

According to the reporter of Lao Dong Newspaper in mid-August, the construction site was still bustling with activities of workers and laborers.

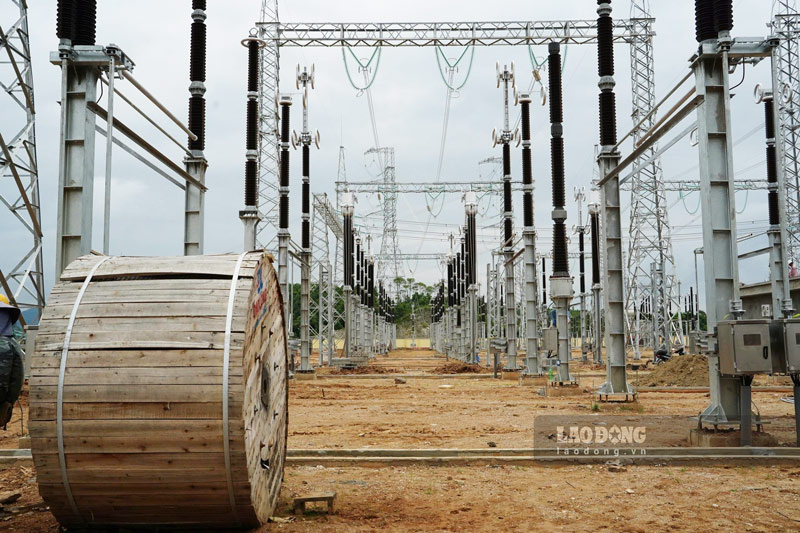

Through observation, a long line of steel pillars, porcelain formwork and equipment serving the operation of the station are in the process of installation. All work is being carried out urgently to soon bring the project to the finish line.

It is known that the 500kV Lao Cai - Vinh Yen Transformer Station started construction in March 2025, constructed by PC1 Group Joint Stock Company.

After many months of construction, the construction, including the following items: construction of gate foundation, equipment support foundation, control house, fire water tank, cable ditch, resistance foundation and transformer, has been completed.

The contractor has also completed the installation of gate posts, scissors, first-line equipment and is preparing to install cutting machines.

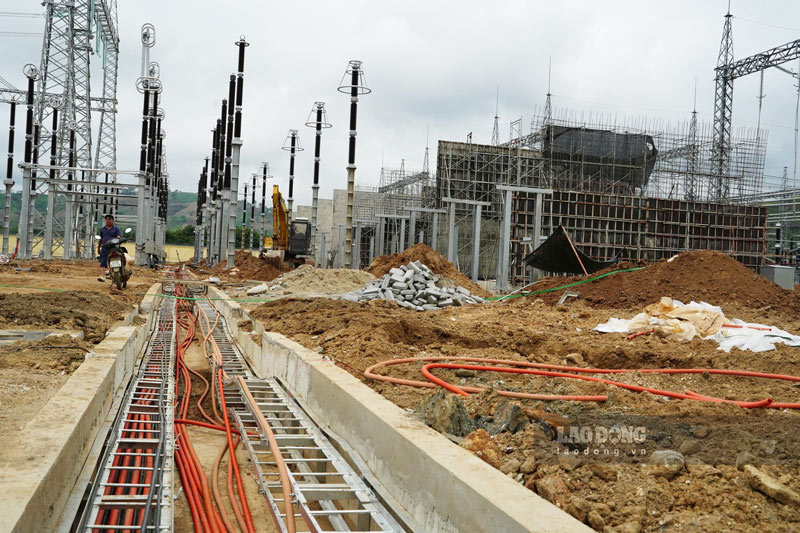

Nhieu hang muc phu cua tram bien ap da hoan thanh. Anh: Dinh Dai
Many additional items of the transformer station have been completed.

According to the report of the construction unit, the project has completed the installation of 85% of equipment, ensuring technical power outage on August 19.

Mr. Dang Hoang An - Chairman of the Board of Members of Vietnam Electricity Group (EVN) - said that the project's site clearance work has completed 468/468 pole foundation locations; handed over the route corridor with 196/242 anchorages, reaching 81%.

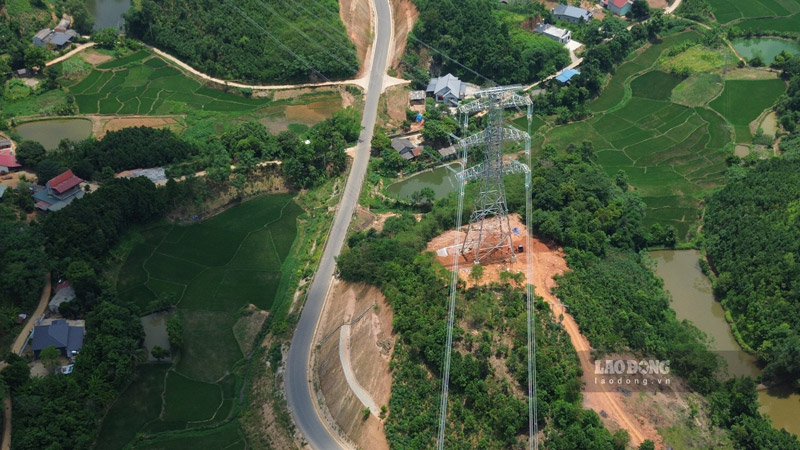

The construction units have completed 468/468 pole foundation locations; installed 306/468 steel column locations, and are transporting, gathering and installing the remaining 162 locations. Along with that, the rope is being spread and pulled at 22/242 anchorage areas.

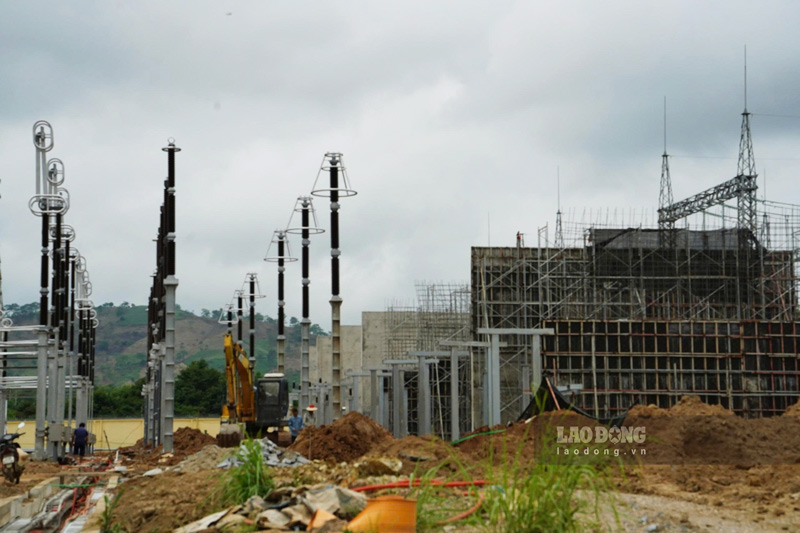

Du an se dong dien ky thuat vao ngay 19.8. Anh: Dinh Dai
The project will be technically energized on August 19.

At the inspection on August 9, Prime Minister Pham Minh Chinh requested that the project must be completed by August 19, 2025 to enhance the safe and stable operation of the National Power System.

Thereby clearing the capacity of hydropower plants in the Northwest region and neighboring provinces, promoting socio-economic development, urban development, industry and services.

A representative of PC1 Group Joint Stock Company informed that with the current progress, the contractor is committed to ensuring that the construction items meet the conditions for technical power outage on August 19, 2025.

Some images recorded at the Lao Cai - Vinh Yen 500kV Transformer Station construction site:

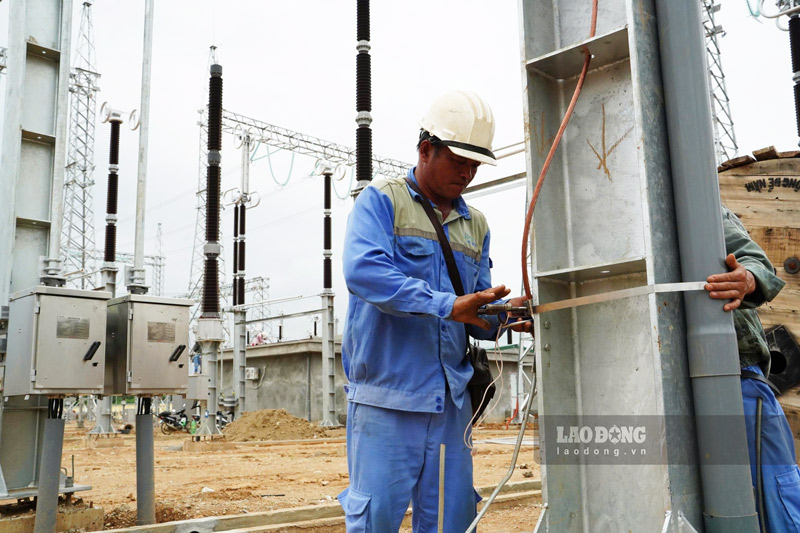

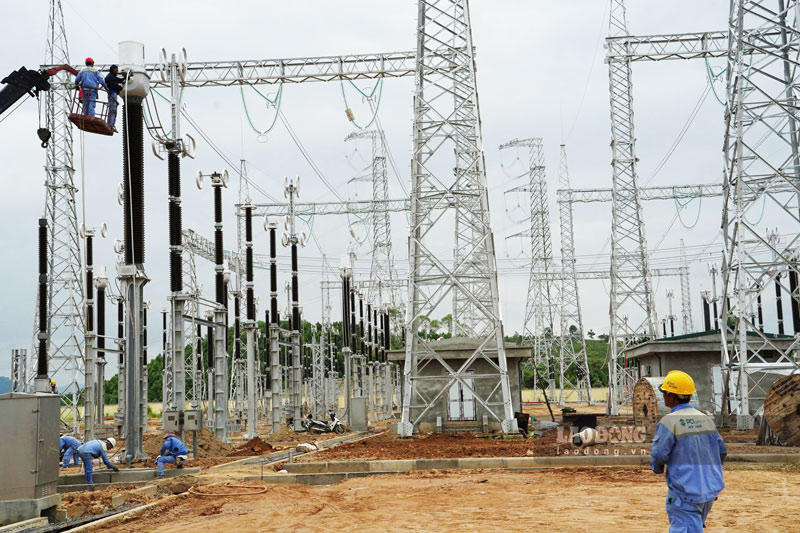

Cac cong nhan dang lap dat thiet bi, cau kien cua tram bien ap.
At the construction site, workers are installing equipment and components of the transformer station.
Cung voi do la he thong cong ranh, duong dien ngam.
Along with that is the sewer system and underground lines.
Cong trinh co y nghia quan trong trong viec dam bao an ninh nang luong, thuc day phat trien hoat dong san xuat.
The project is of great significance in ensuring energy security and promoting the development of production activities.
Viec som dua du an giup thuc day phat trien kinh te xa hoi cho cac tinh xung quanh khu vuc. Anh: Dinh Dai
The early implementation of the project helps promote socio-economic development, industry and services for the provinces around the region.
Vi vay, nhung ngay sat thoi han, khi the tren cong truong lai cang nong hon bao gio het.
Therefore, on the days before the deadline, the atmosphere at the construction site is hotter than ever. Photo: Dinh Dai
Đinh Đại
RELATED NEWS

Continue to focus on taking care of workers constructing the 500kV Lao Cai - Vinh Yen line

|

The leaders of the Vietnam General Confederation of Labor directly presented gifts and encouraged workers constructing the 500kV Lao Cai - Vinh Yen line.

The Electricity Trade Union presented 228 million VND to workers on the 500kV Lao Cai - Vinh Yen power line

|

The leaders of the Vietnam Electricity Trade Union encouraged workers constructing the 500kV Lao Cai - Vinh Yen transmission line.

Must be constructed as quickly as the 500kV project circuit 3

|

The 500kV Lao Cai - Vinh Yen transmission line is a strategic project on national energy security, providing enough electricity to serve production and business activities and people's daily life, attracting investment, and developing the socio-economy of the Northwest region.

9th Hour No. 202: Bitter Loop - Part 1

|

Hour 9 - The blissful facade shattered after the husband's overseas business trip with his ex-lover. Can the wife save the shaking home?

Lightning strikes through the roof, burning furniture of a household in Da Nang

|

Da Nang - A house in Dai Loc commune had its corrugated iron roof blown through by lightning, burning many belongings, and the whole family luckily escaped.

People are worried because a power pole blocks a road worth more than 20,000 billion VND in Ho Chi Minh City

|

Ho Chi Minh City - Nguyen Thi Dinh street is being expanded, many power poles have not been moved, and construction materials are scattered for a long time, making it difficult for people to travel.

Vietnam Fatherland Front innovates activities in ethnic affairs

|

Conclusion No. 01/KL-MTTW-ĐCT sets out the requirement to innovate the activities of the Vietnam Fatherland Front and socio-political organizations in ethnic affairs to 2030, with a vision to 2045.

157 students from remote islands in An Giang pack their bags and go ashore to take the high school graduation exam

|

An Giang - 157 students in Kien Hai special zone enter Rach Gia ward to take the 2026 high school graduation exam.

Continue to focus on taking care of workers constructing the 500kV Lao Cai - Vinh Yen line

Hà Anh |

The leaders of the Vietnam General Confederation of Labor directly presented gifts and encouraged workers constructing the 500kV Lao Cai - Vinh Yen line.

The Electricity Trade Union presented 228 million VND to workers on the 500kV Lao Cai - Vinh Yen power line

Đắc Cường |

The leaders of the Vietnam Electricity Trade Union encouraged workers constructing the 500kV Lao Cai - Vinh Yen transmission line.

Must be constructed as quickly as the 500kV project circuit 3

Lê Thanh Phong |

The 500kV Lao Cai - Vinh Yen transmission line is a strategic project on national energy security, providing enough electricity to serve production and business activities and people's daily life, attracting investment, and developing the socio-economy of the Northwest region.
